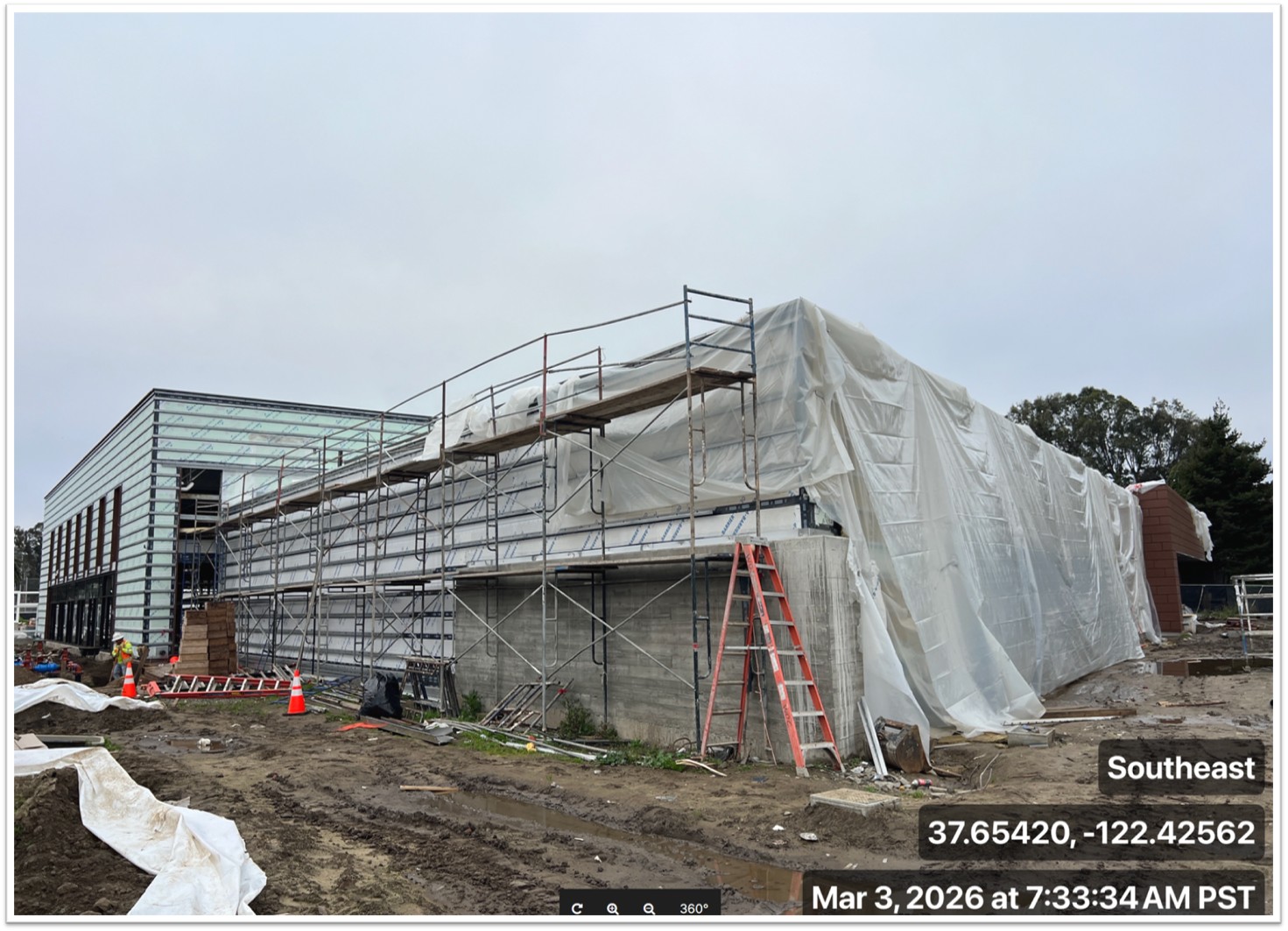

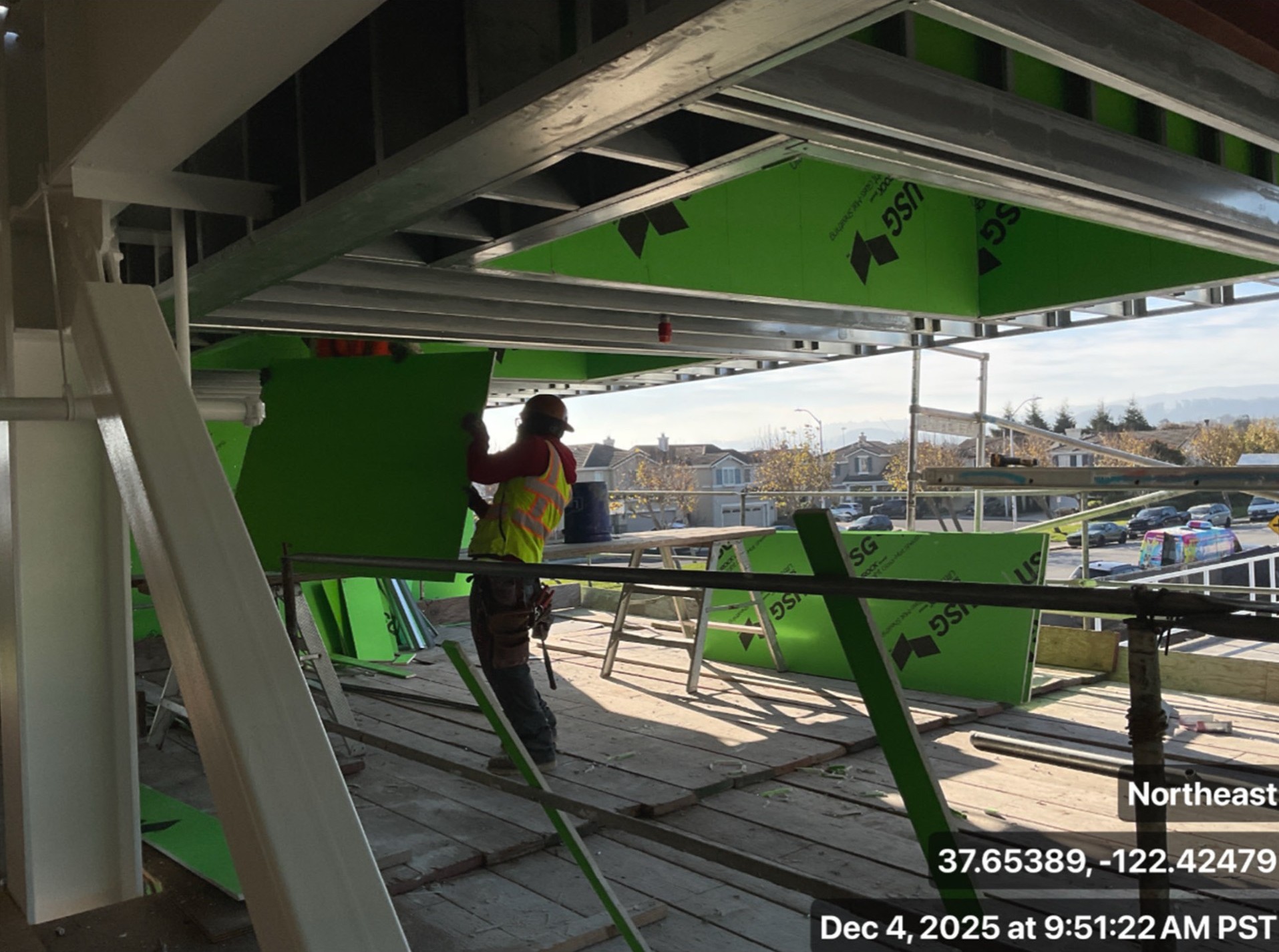

Construction Update - 12/29/25
The Orange Memorial Park Aquatic Center continues to make significant strides as 2025 comes to a close. With key overhead and envelope milestones underway, the project is progressing steadily toward its final architectural form.

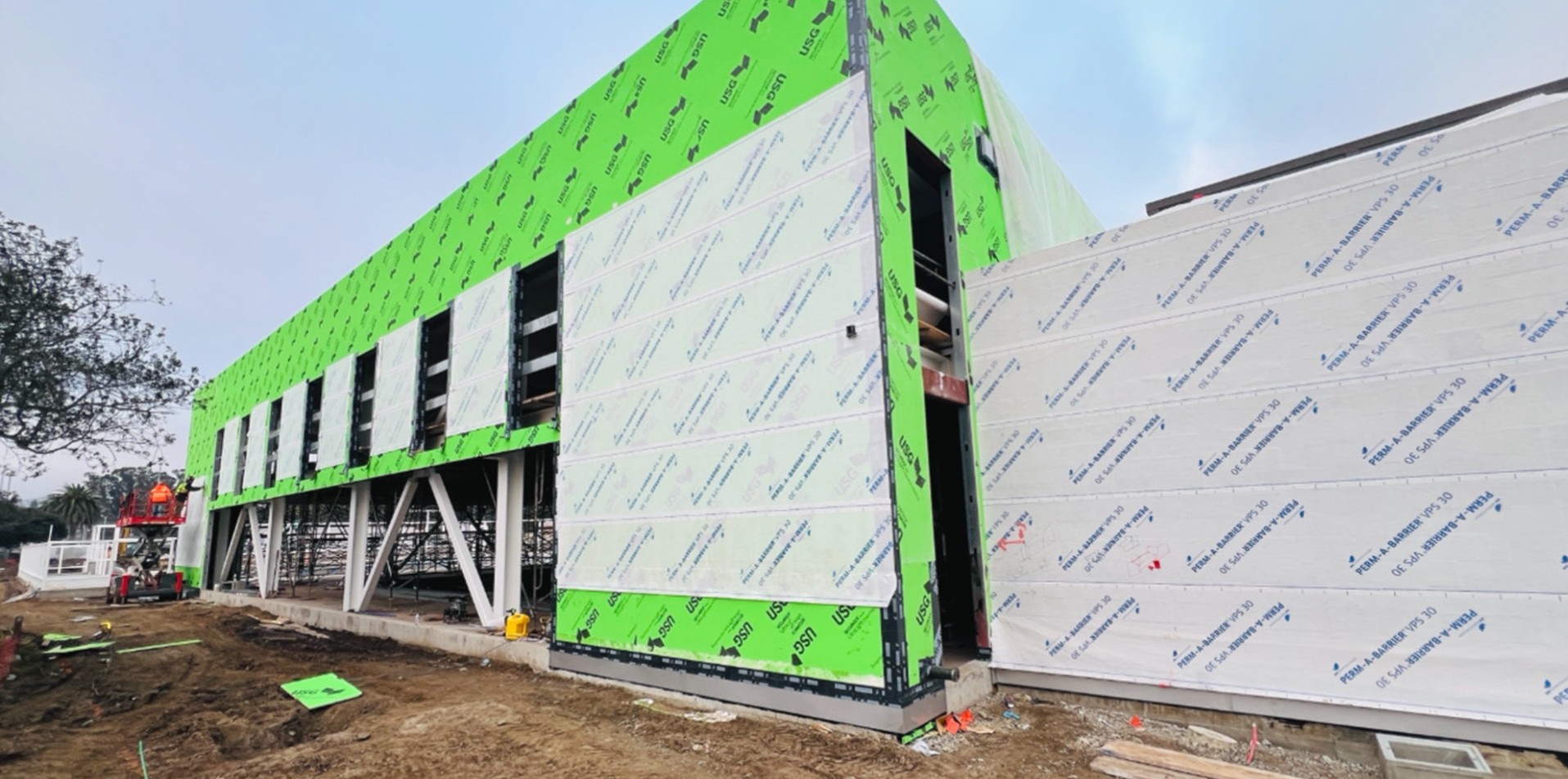

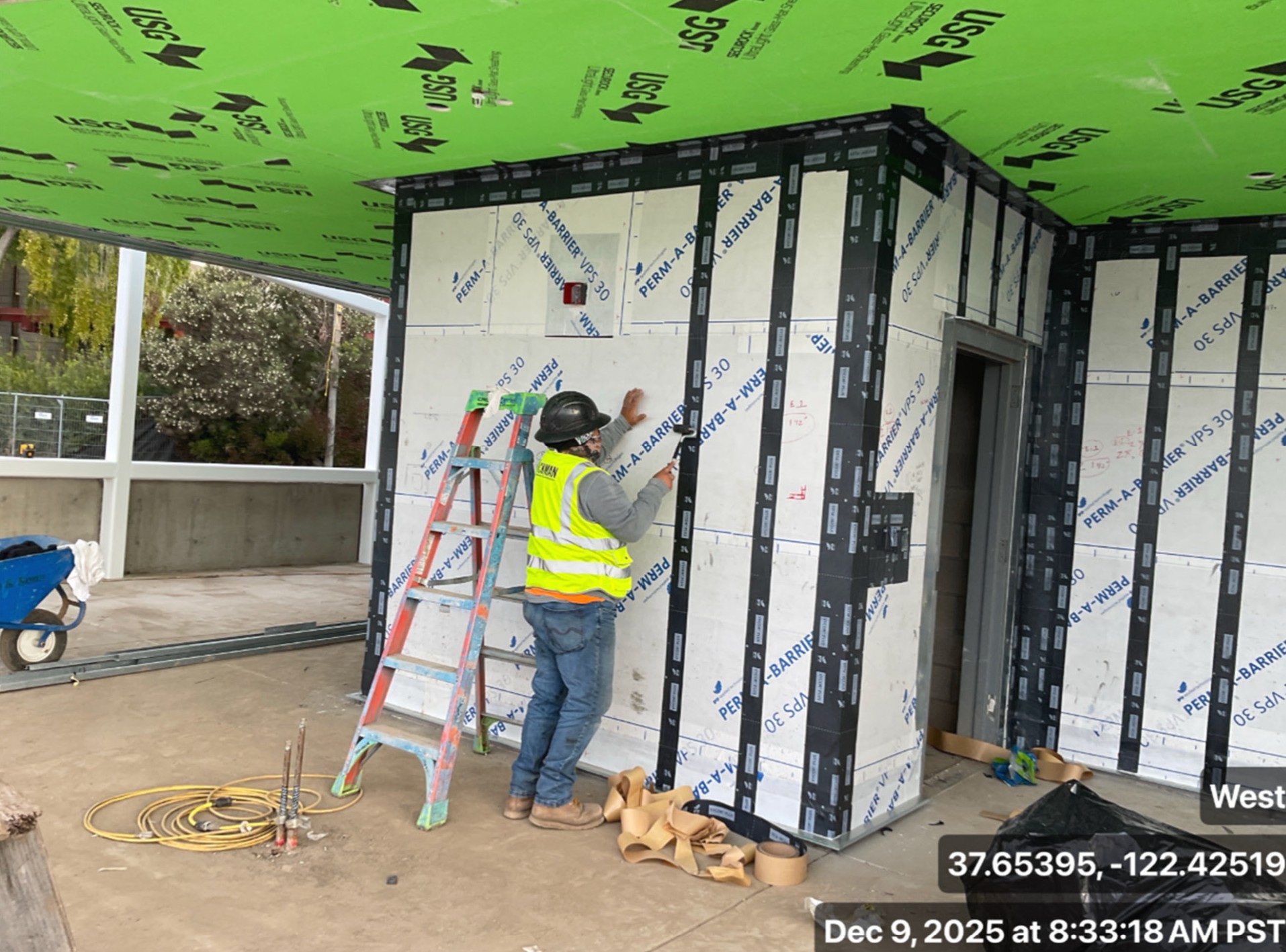

Recent efforts have focused on painting, overhead MEP installations, rooftop preparations, mechanical room work, and ongoing insulation. Site activity remains robust with coordinated trades across all wings of the facility.
Work highlights from November and December:

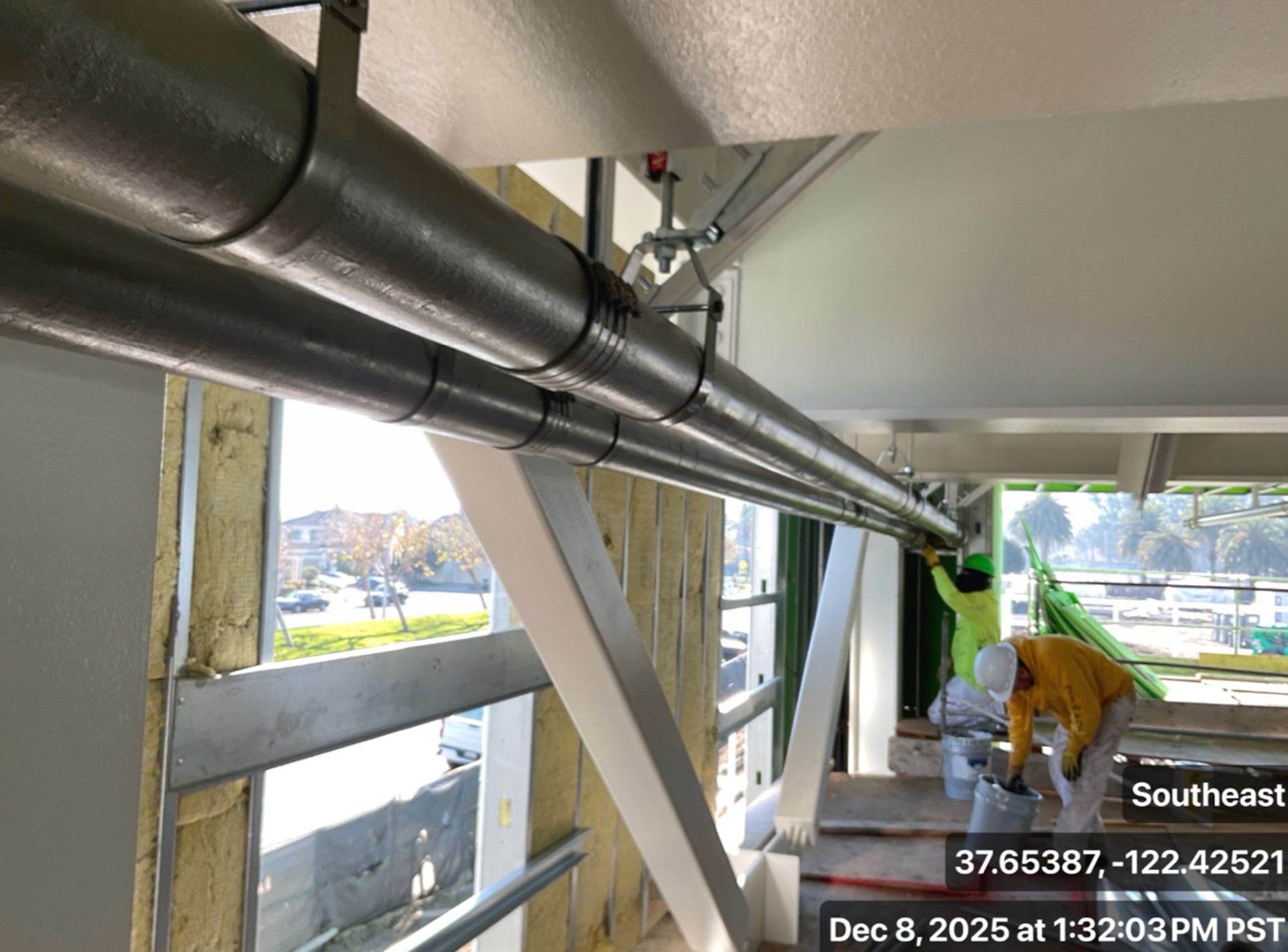

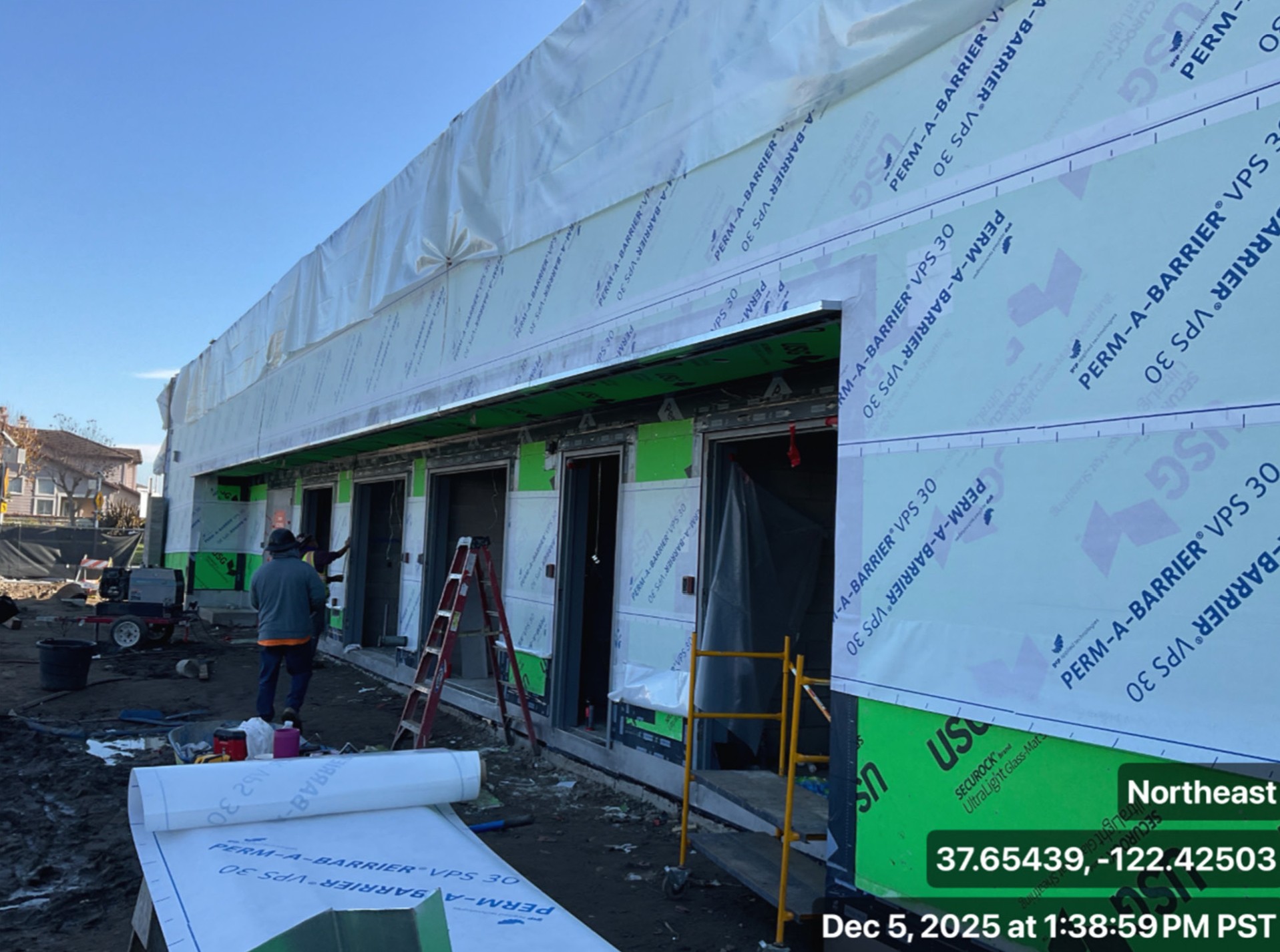

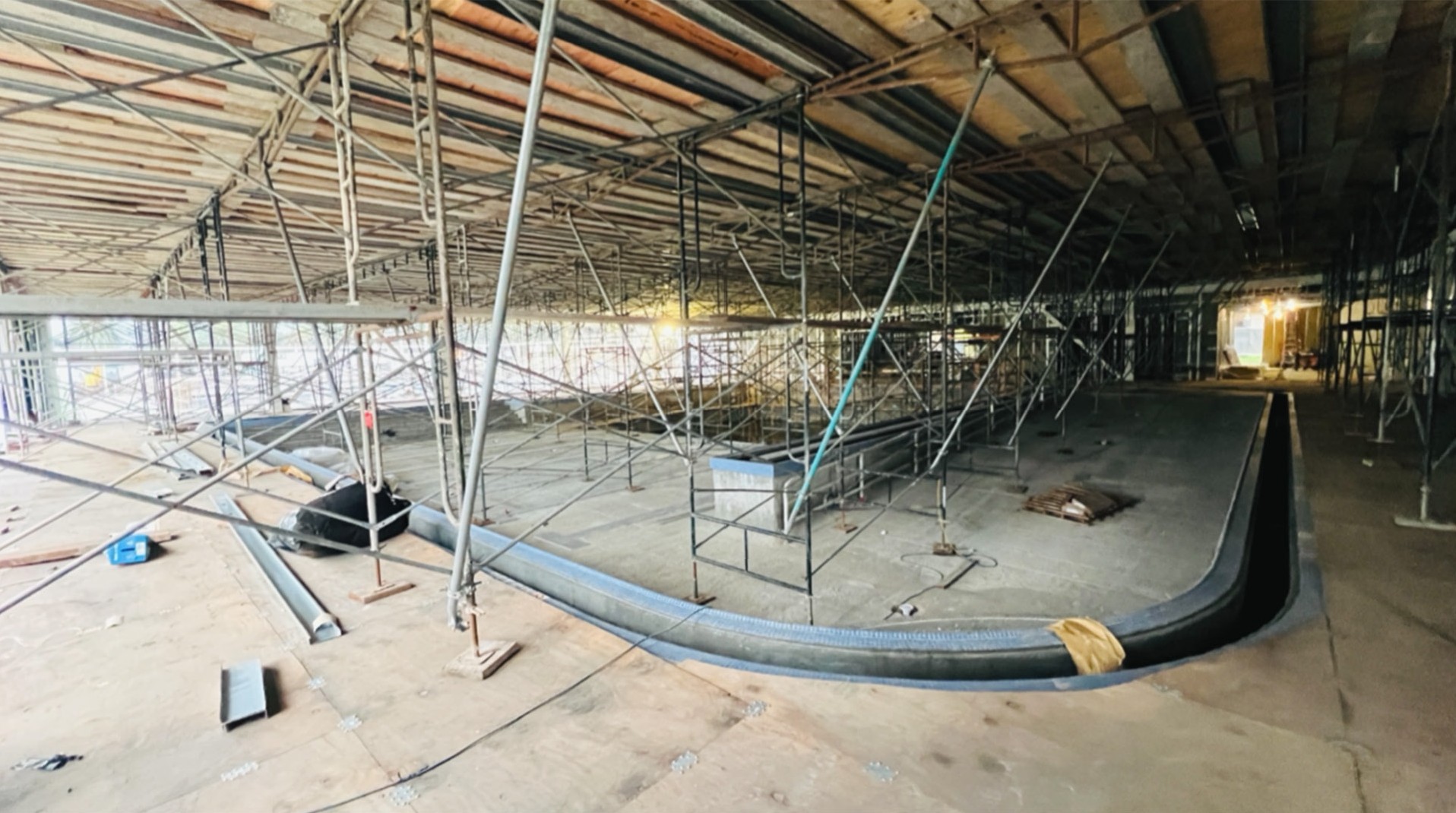

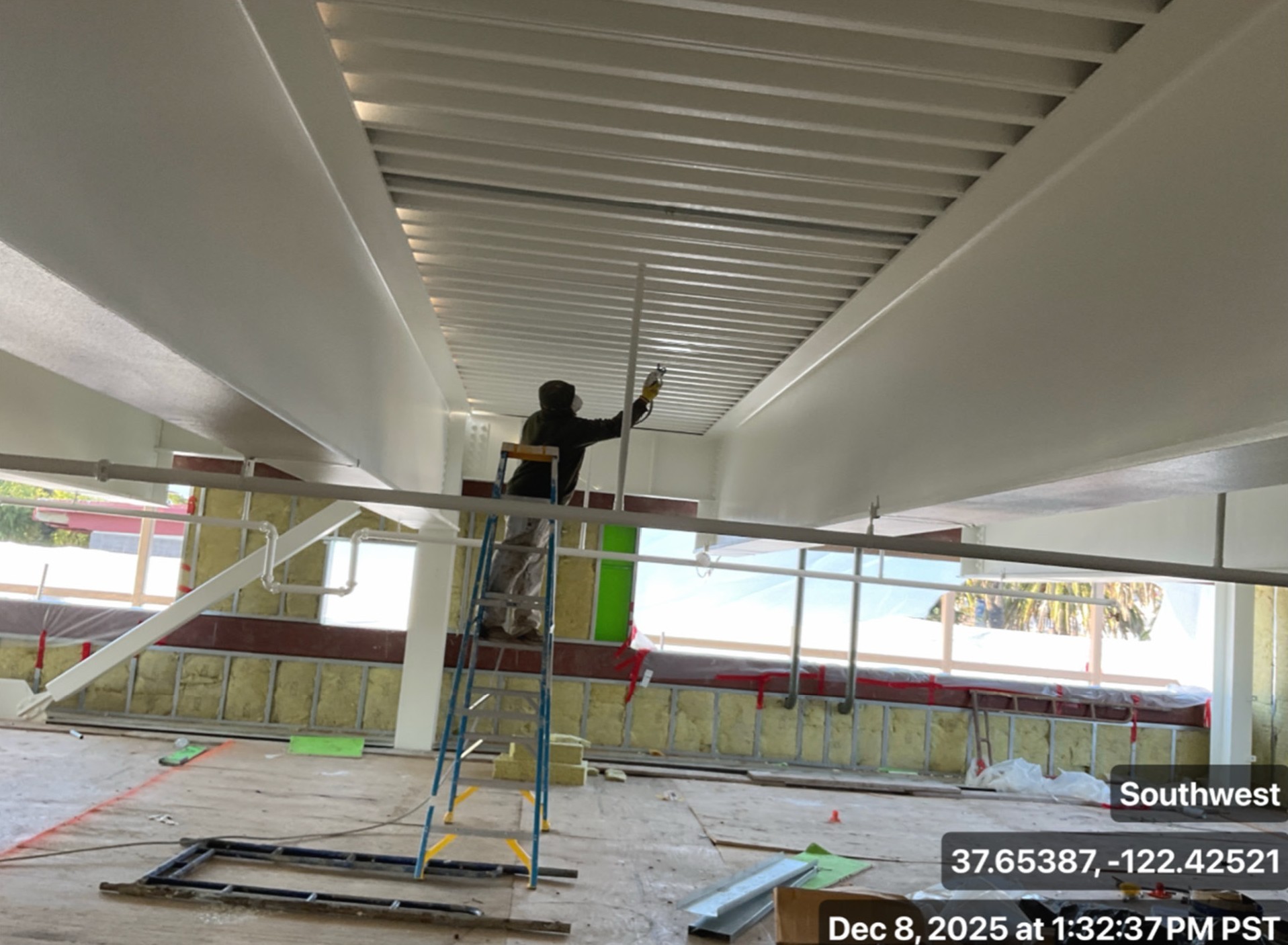

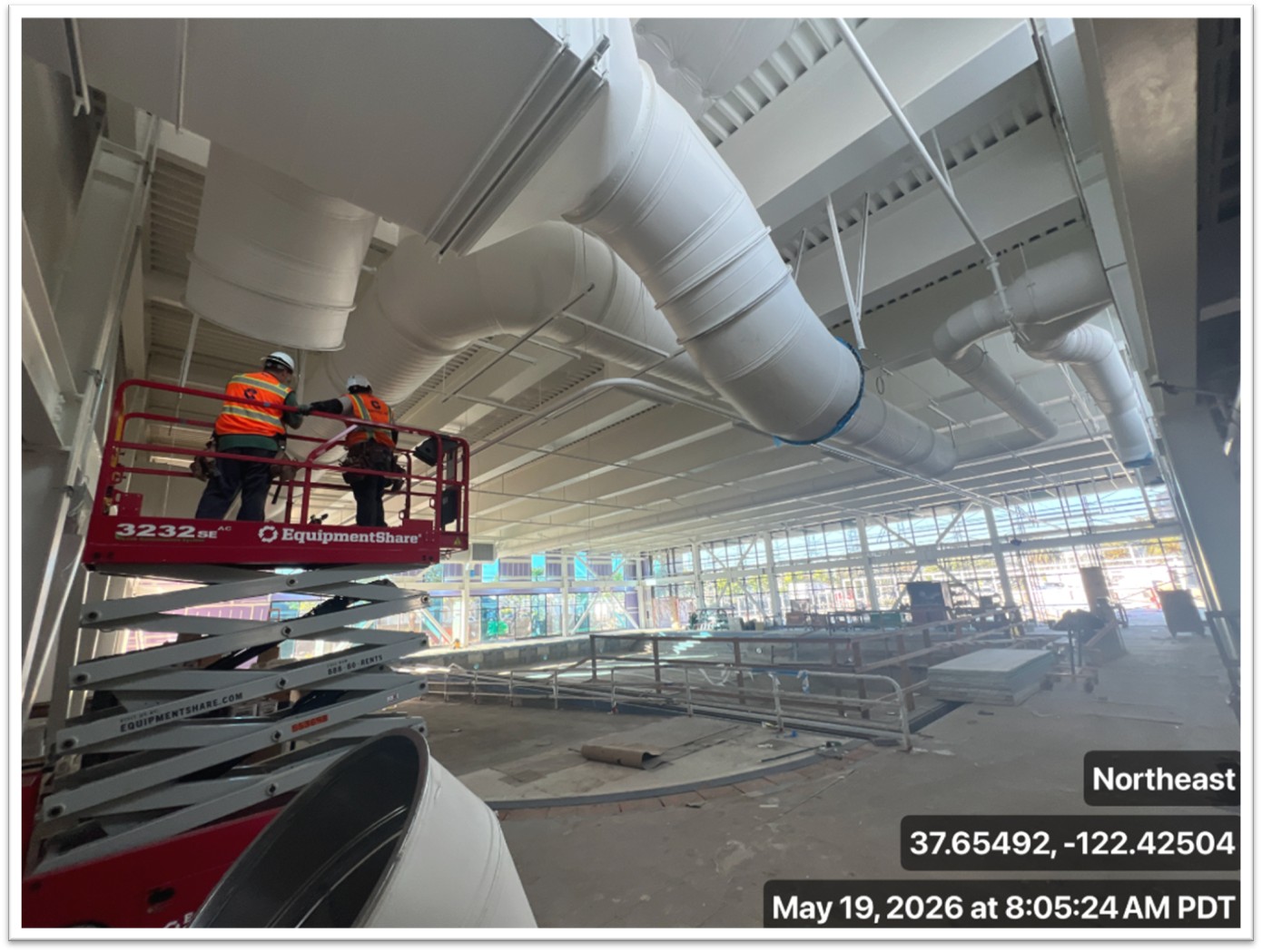

- Overhead painting has been completed in key natatorium areas, clearing the way for HVAC and lighting fixture installation to begin on schedule.

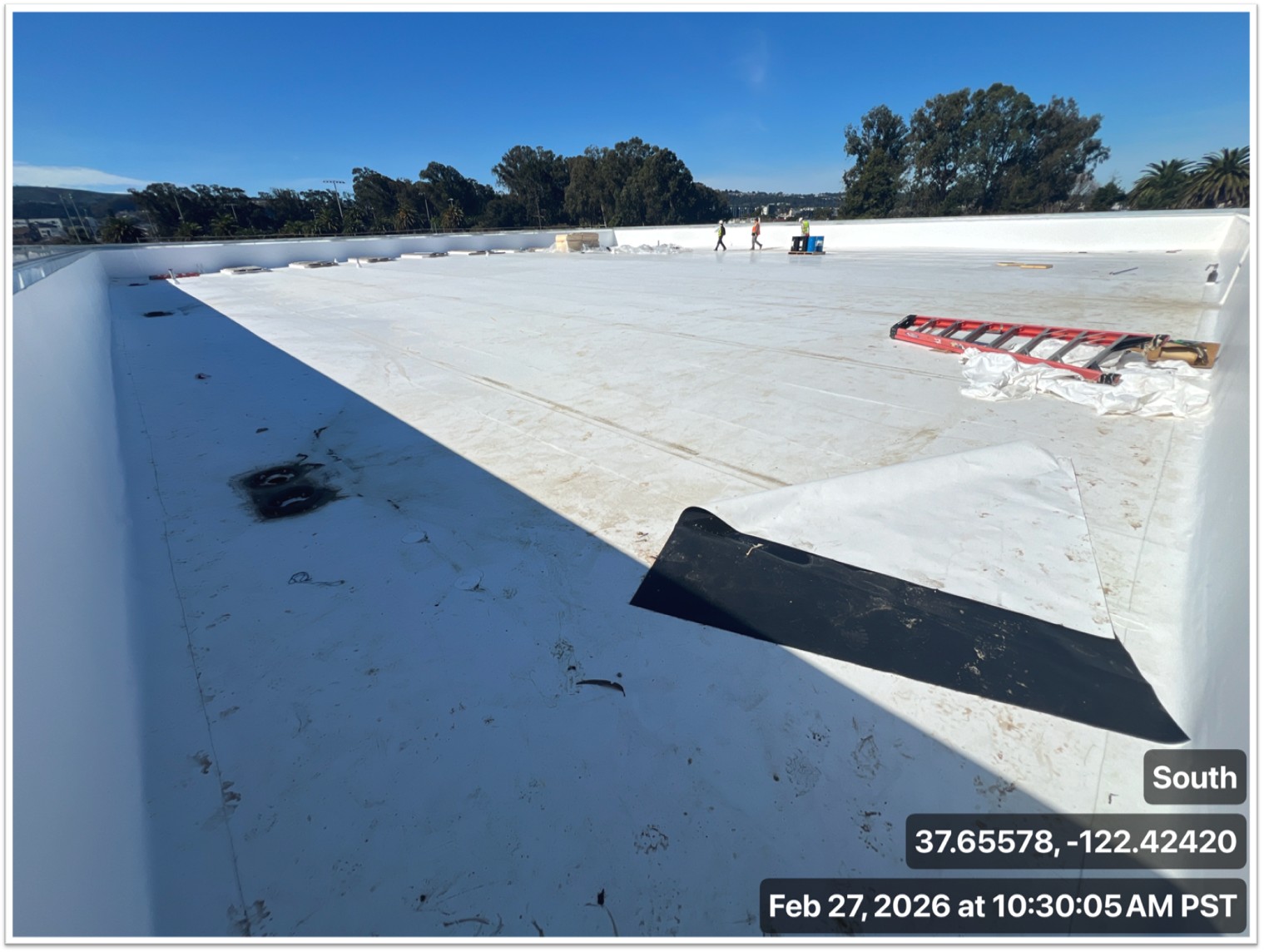

- Rooftop curbs have been installed and inspected, with roof waterproofing prep now underway.

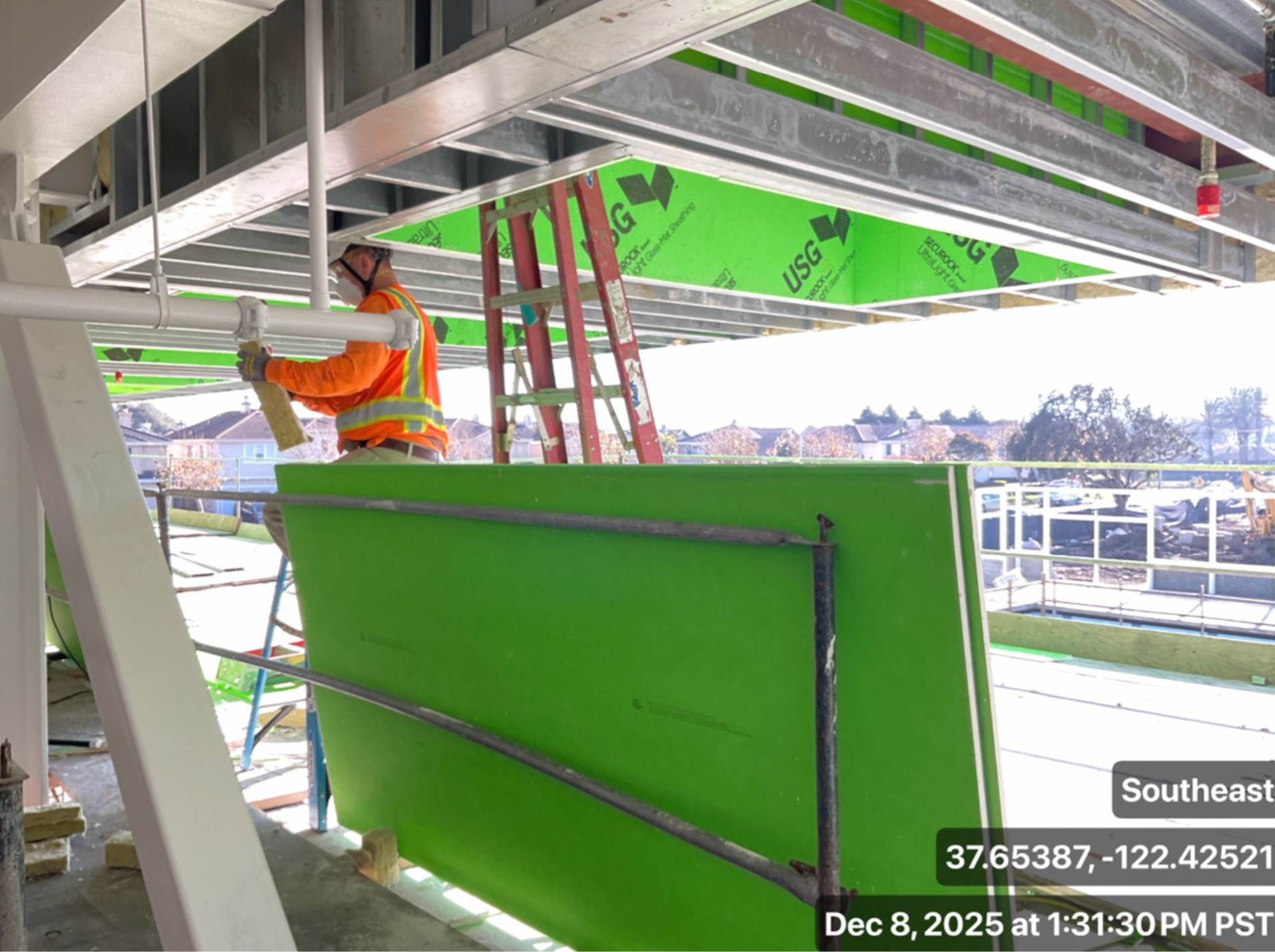

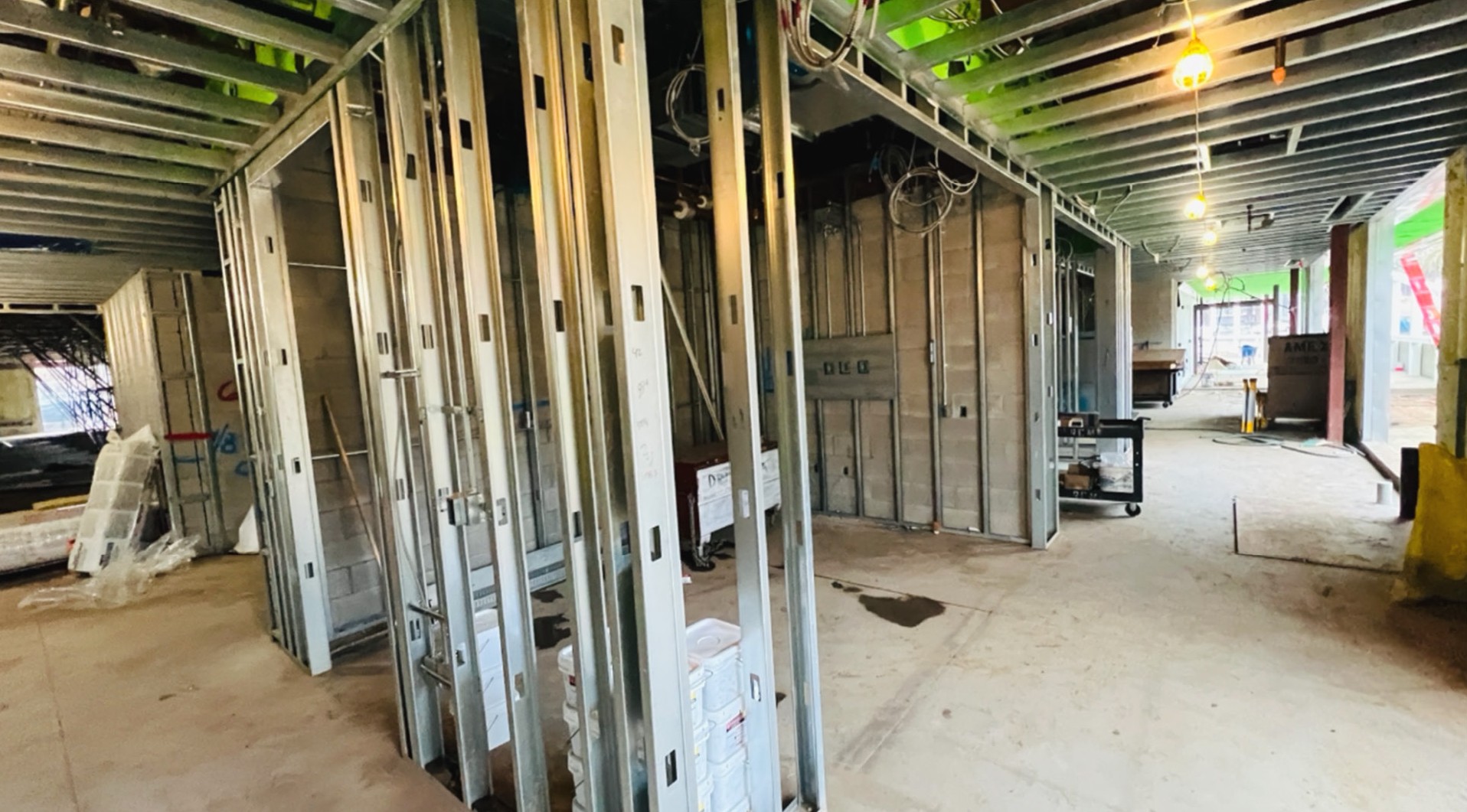

- Wall and ceiling insulation is in progress across multiple zones.

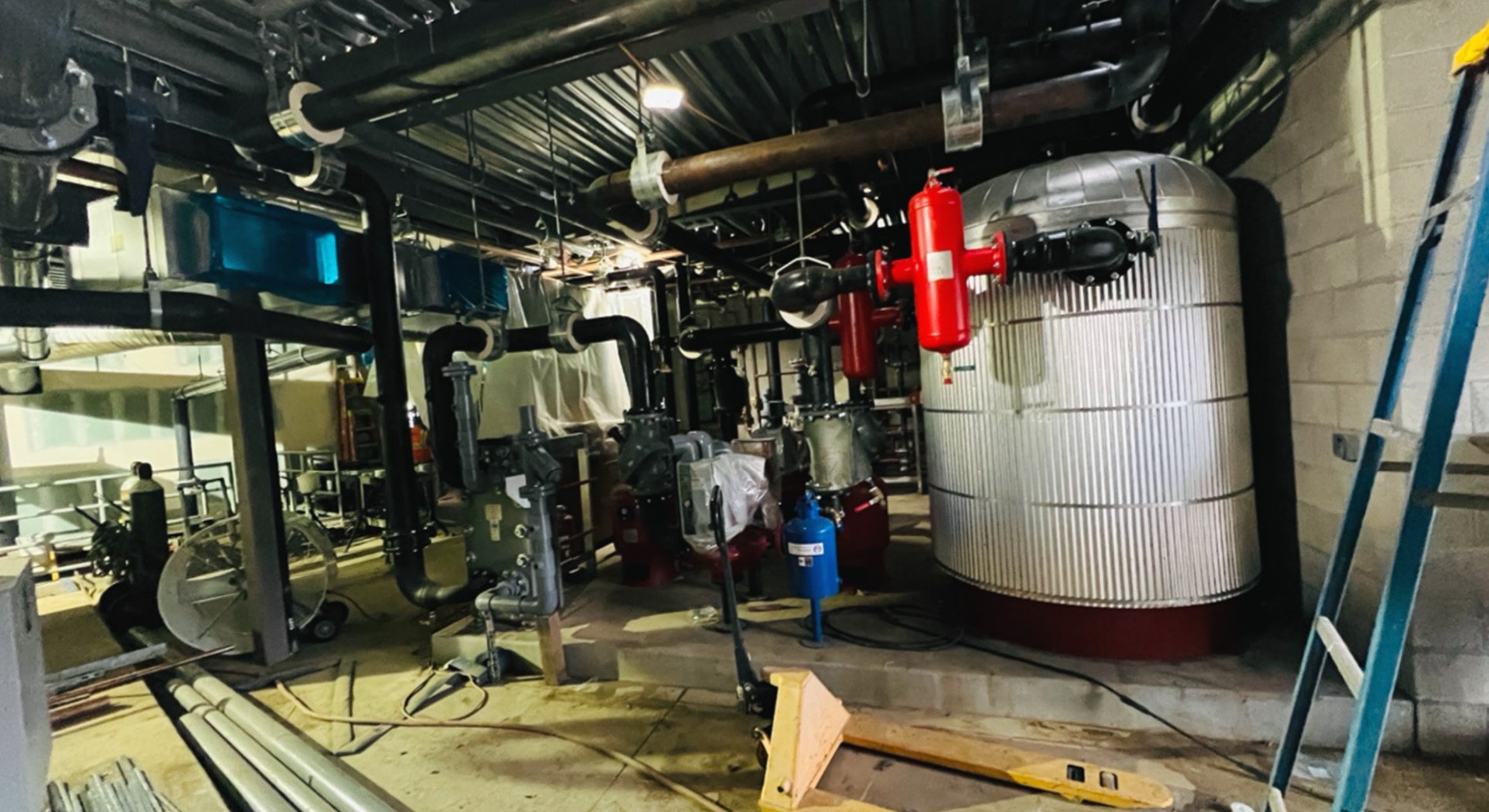

- Mechanical and electrical rooms are actively receiving equipment and connections.

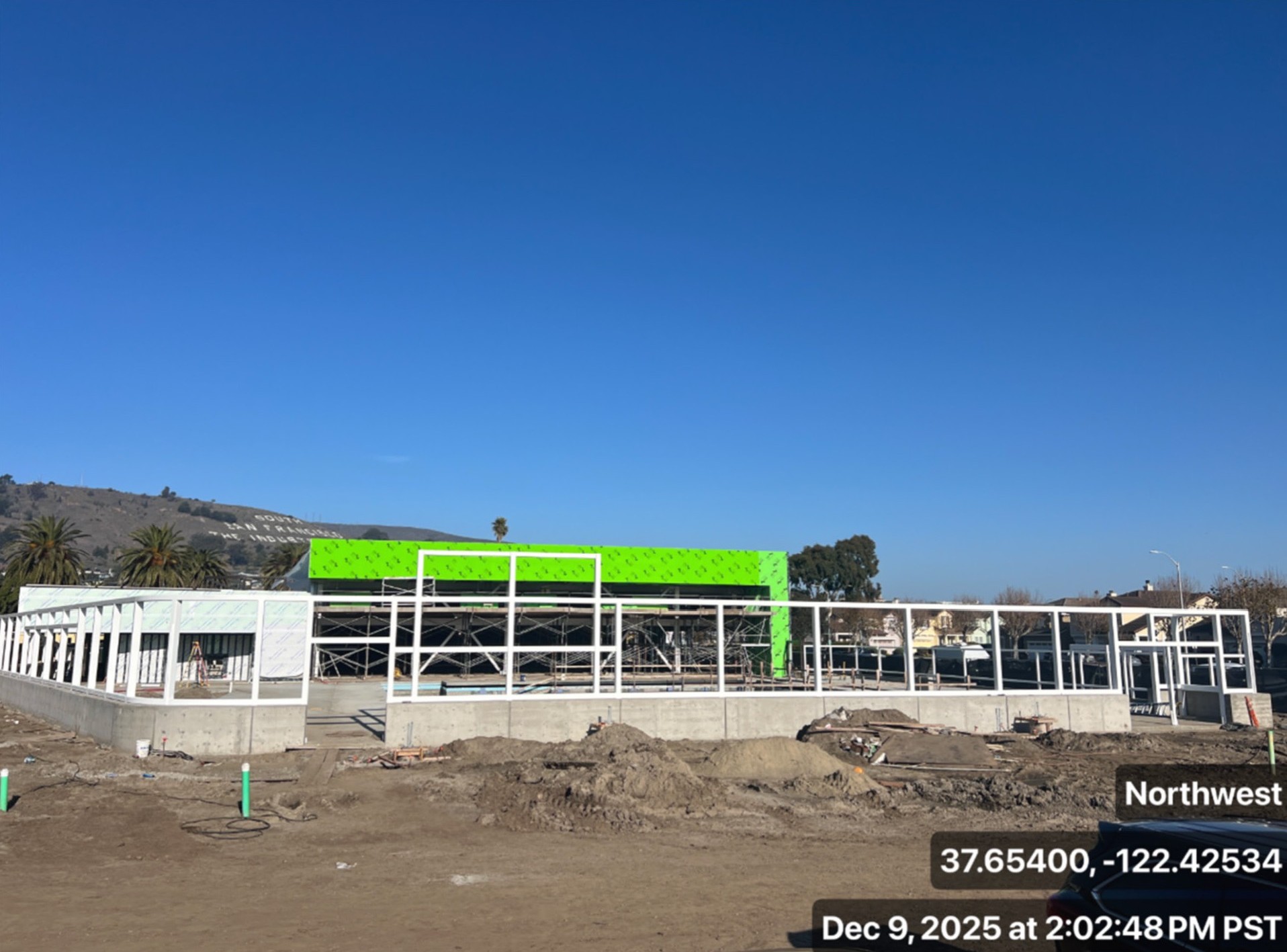

- Scoreboard and light pole footings are complete near the outdoor pool; painting of wind screen fencing has also wrapped up.

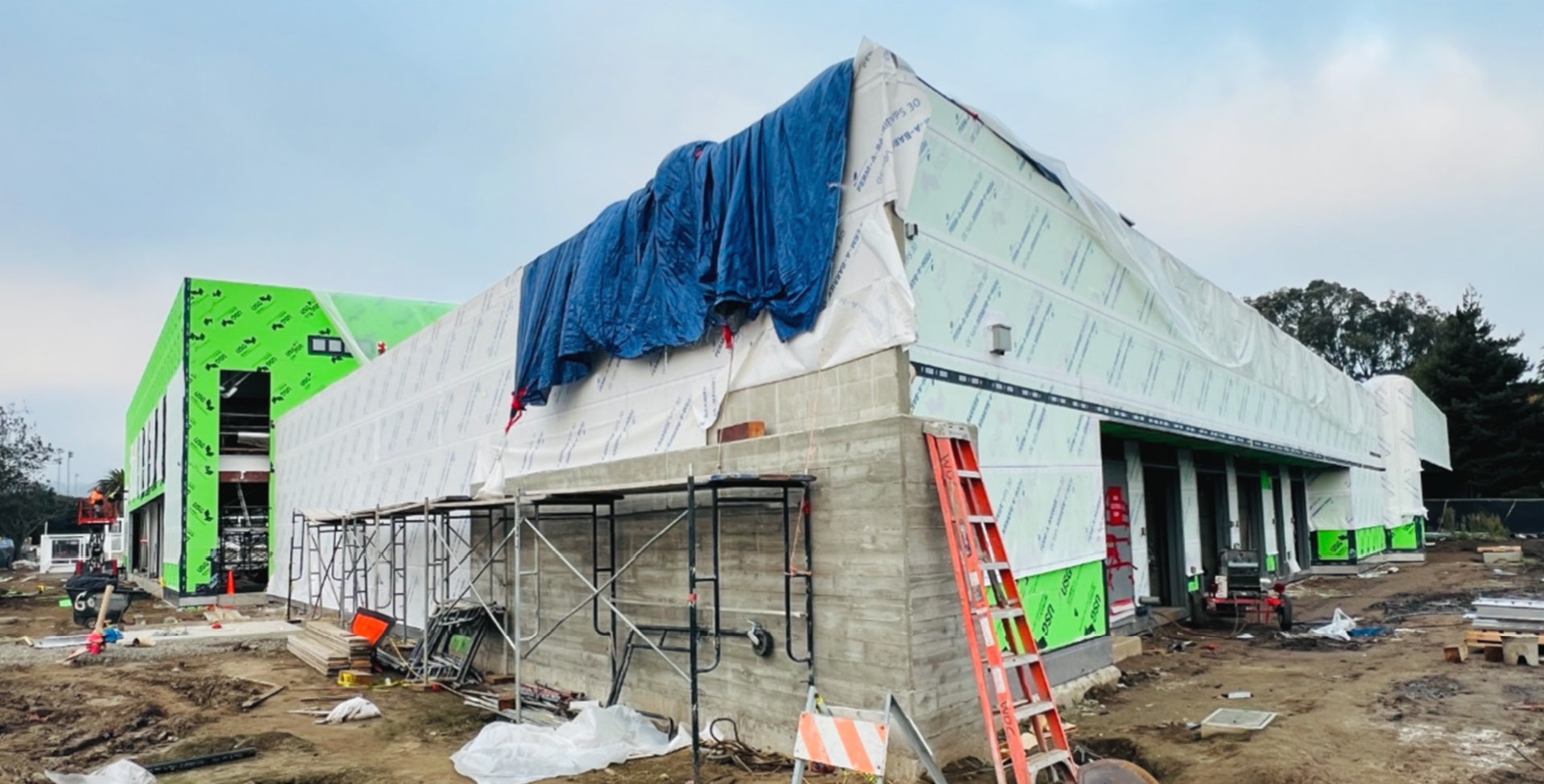

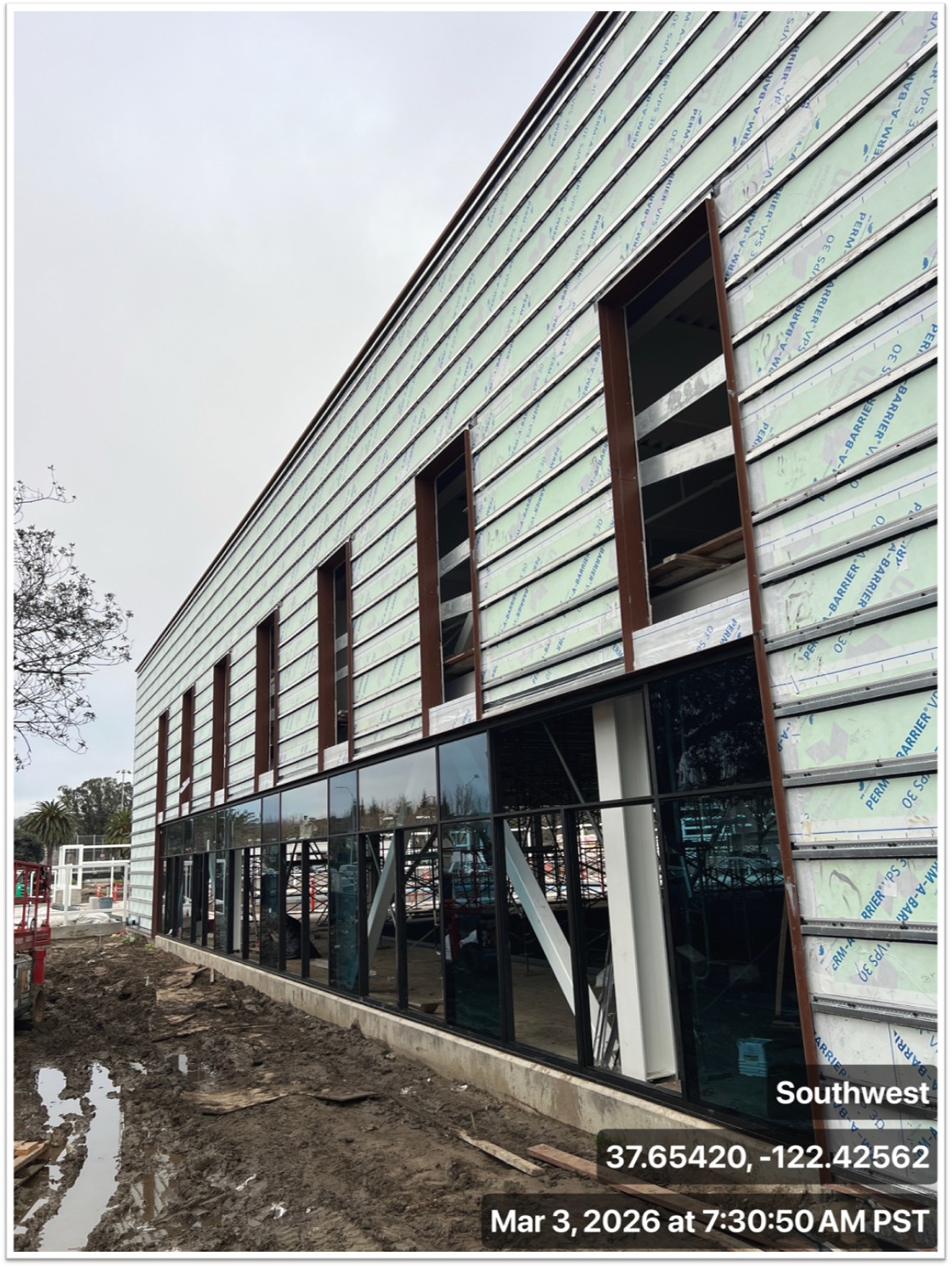

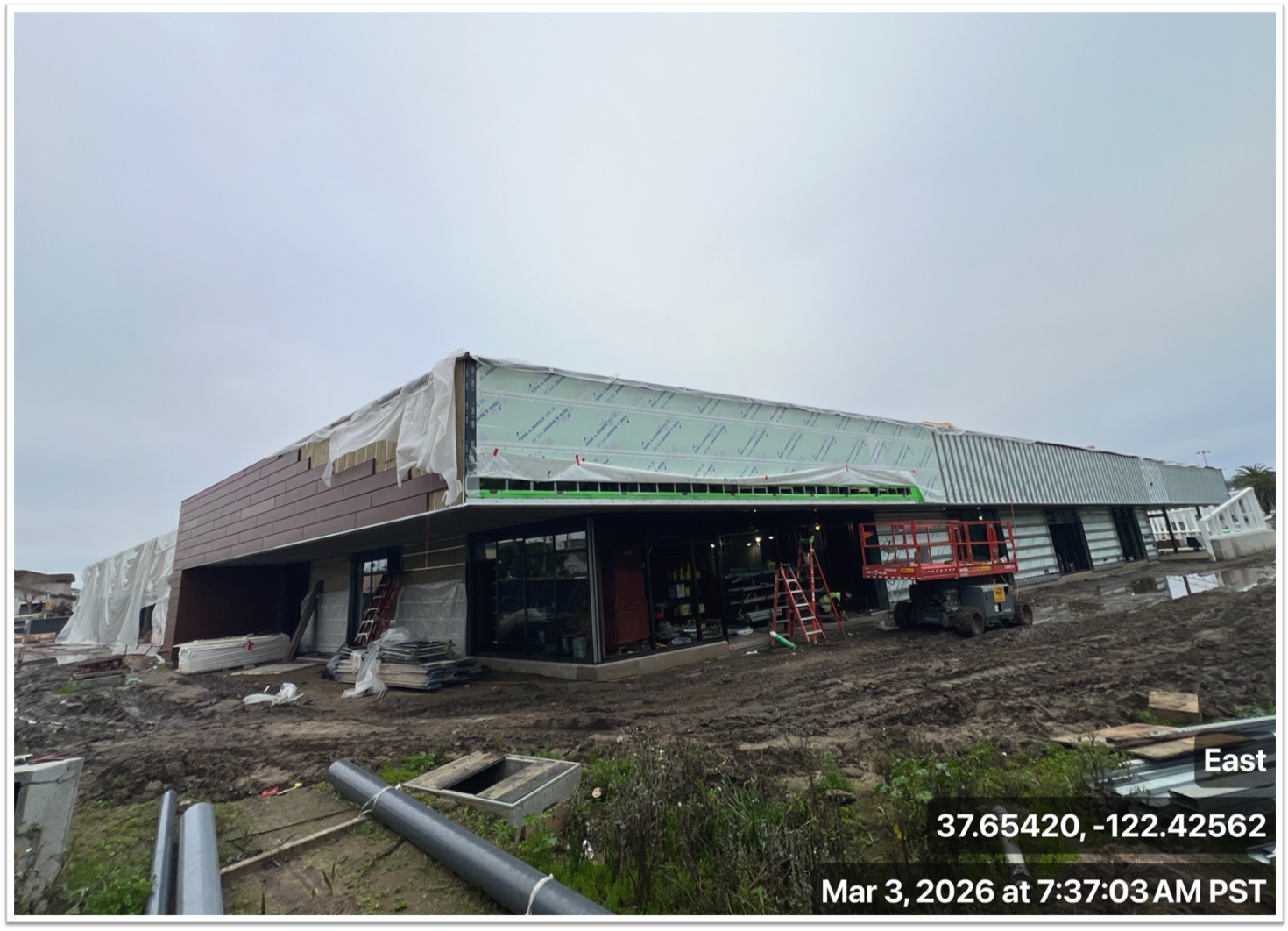

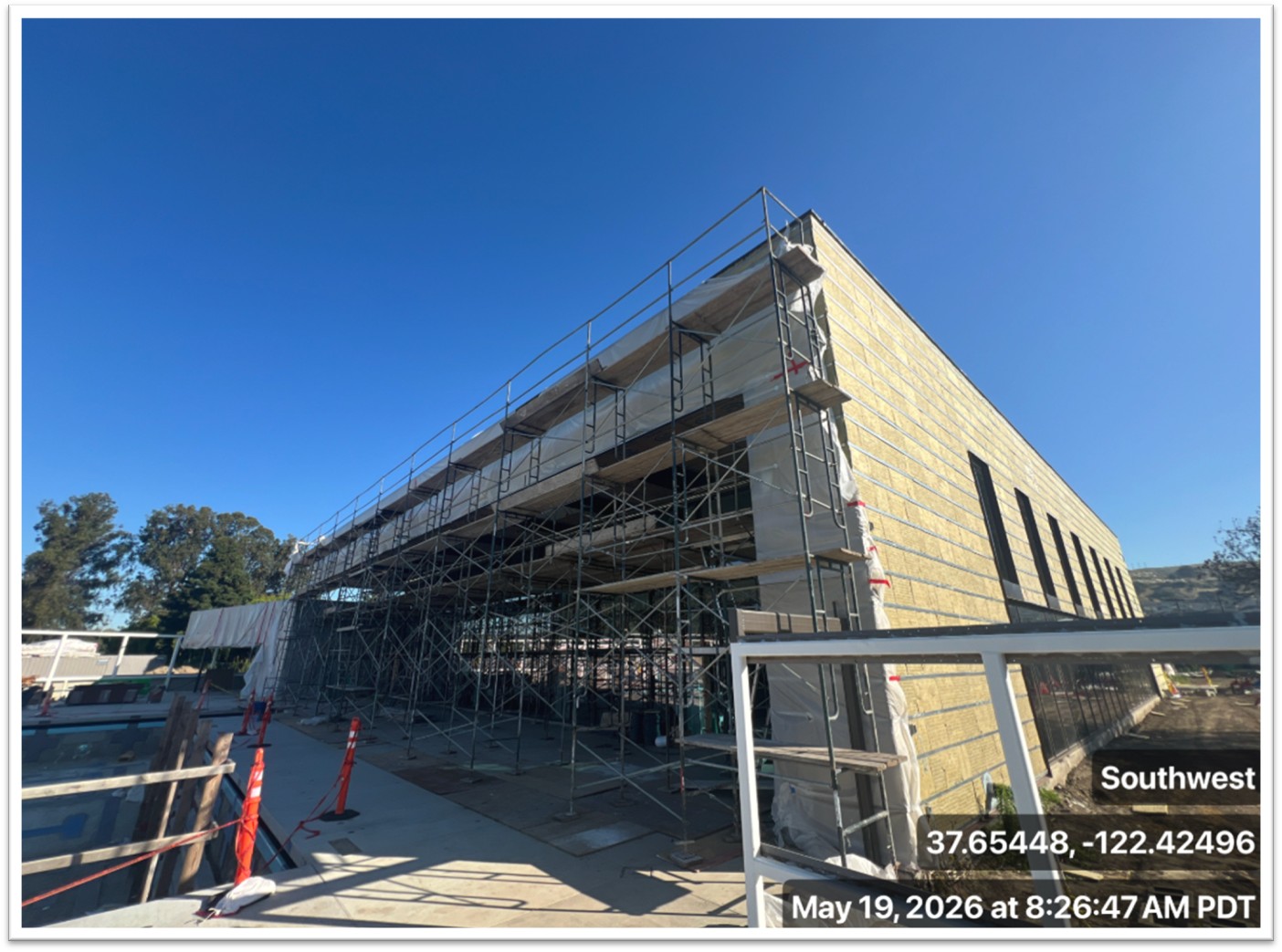

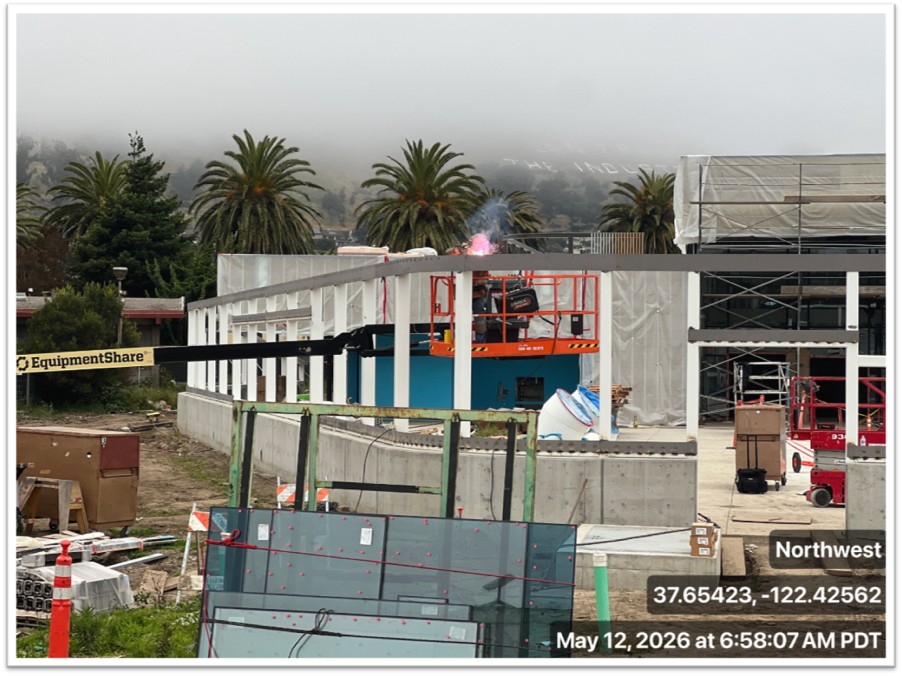

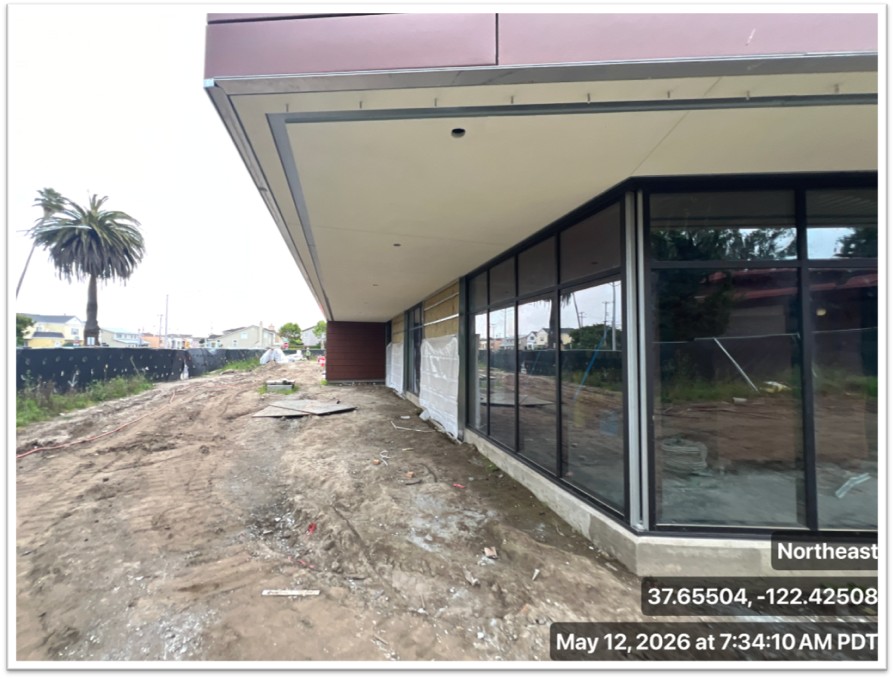

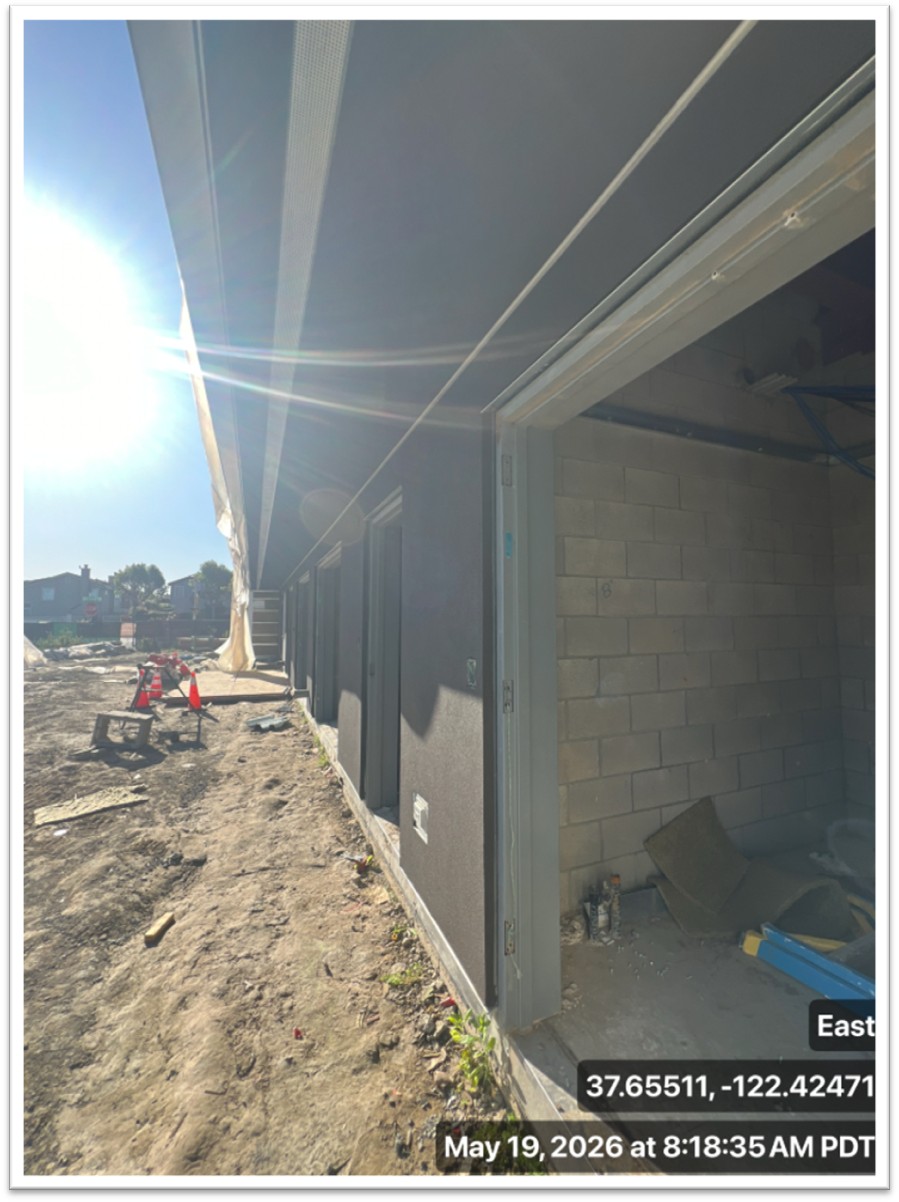

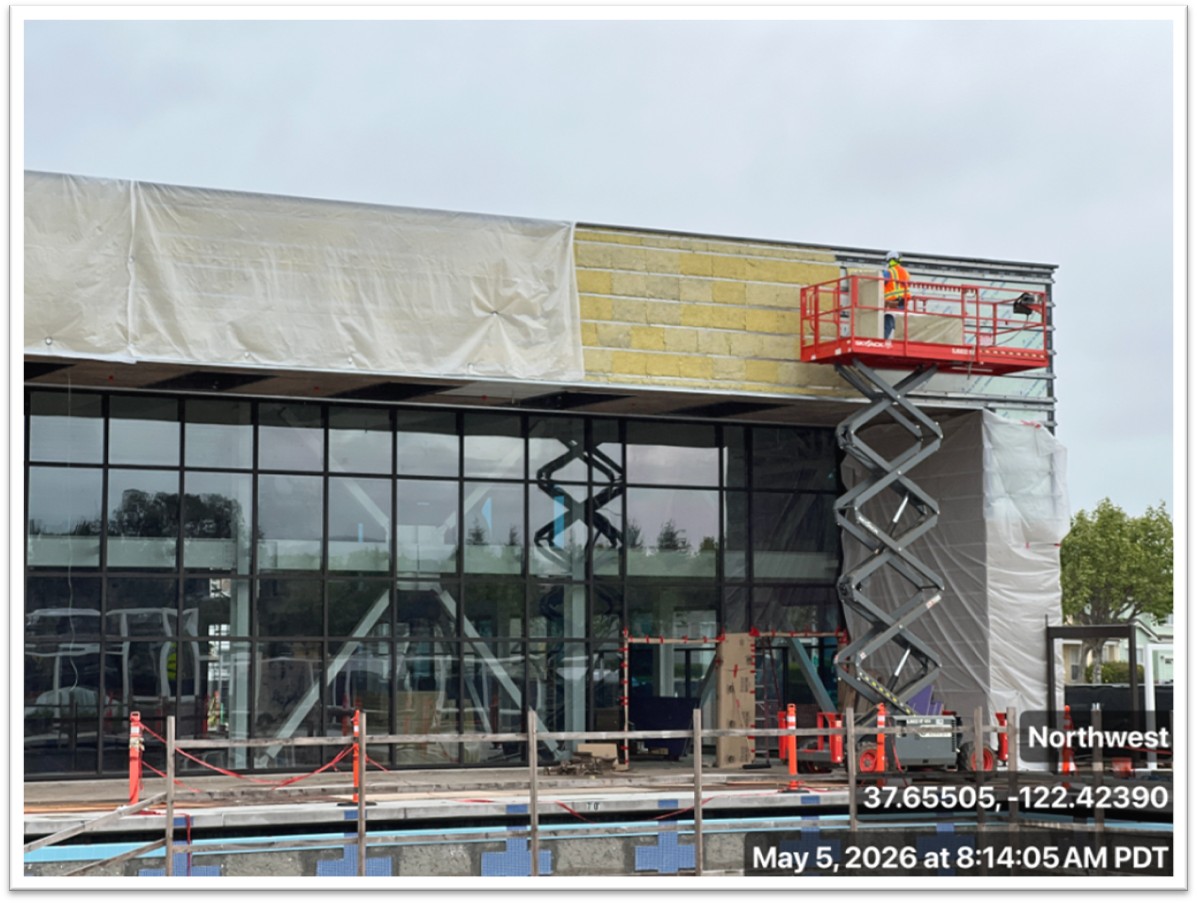

- The team is preparing for storefront and composite siding installation in the upcoming weeks, which will begin to shape the final appearance of the facility.

Public Art - 9/20/25

Community members are encouraged to view and provide feedback on art concept proposals for a public art interior wall mural at the New Aquatic Center at Orange Memorial Park.
Meet the prospective artists or their representatives.
Where: Concert in the Park, Orange Memorial Park meadow near the Parks and Recreation tents
Date: Saturday, September 20, 2025
Time: Between 11:30 a.m. and 1:00 p.m.
See the flyer in English (or in Spanish)
The art concept proposals will be available for viewing and to share your feedback at the Orange Pool lobby and on this project page 9/21-10/3.
Help shape the artwork that will brighten and inspire our community for years to come!
See the mural concepts and provide your input!

Take the survey
Survey closes on October 3, 2025.
Construction Update - 9/12/25

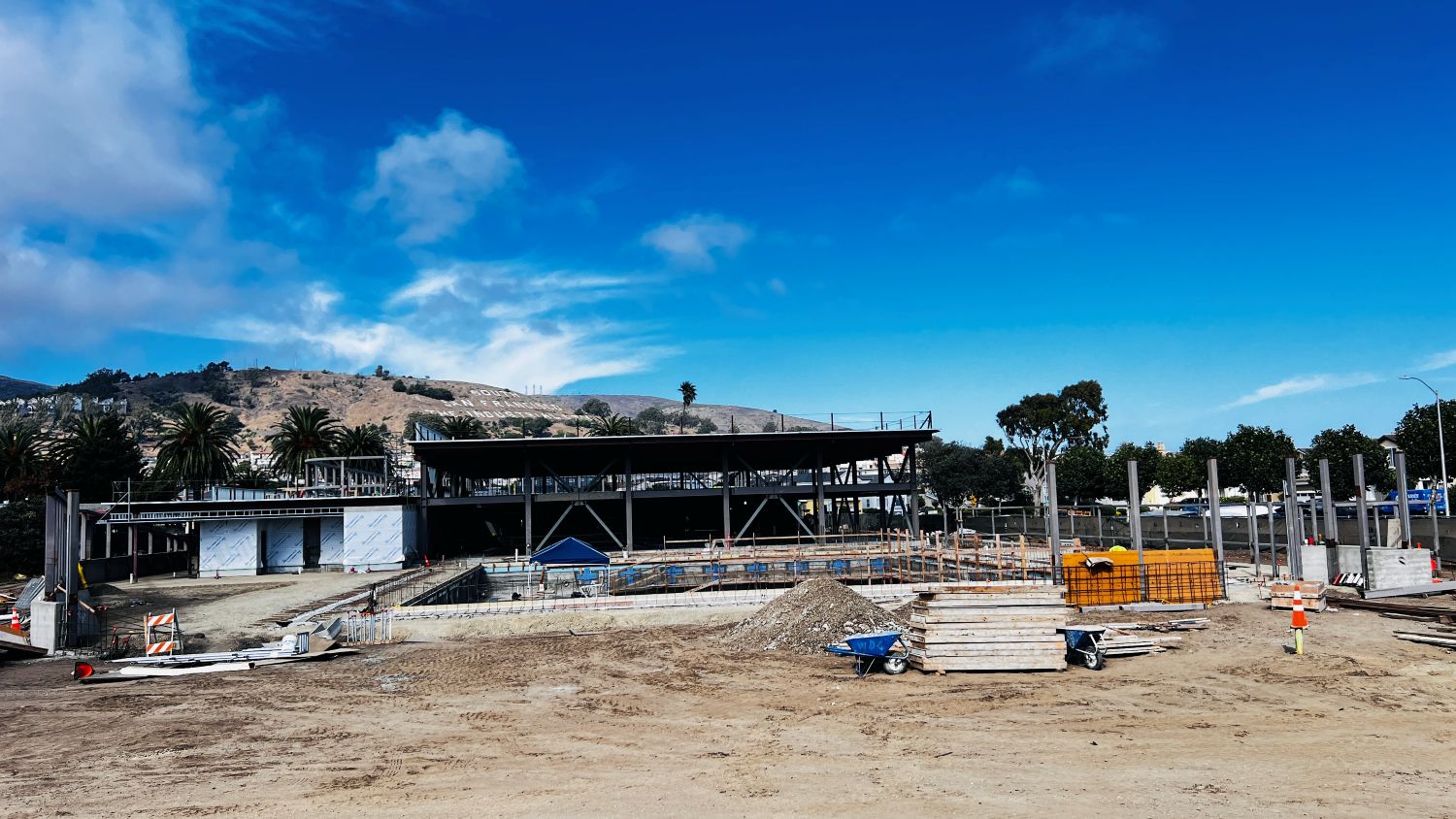

Construction at the Aquatic Center continues to make strong progress.

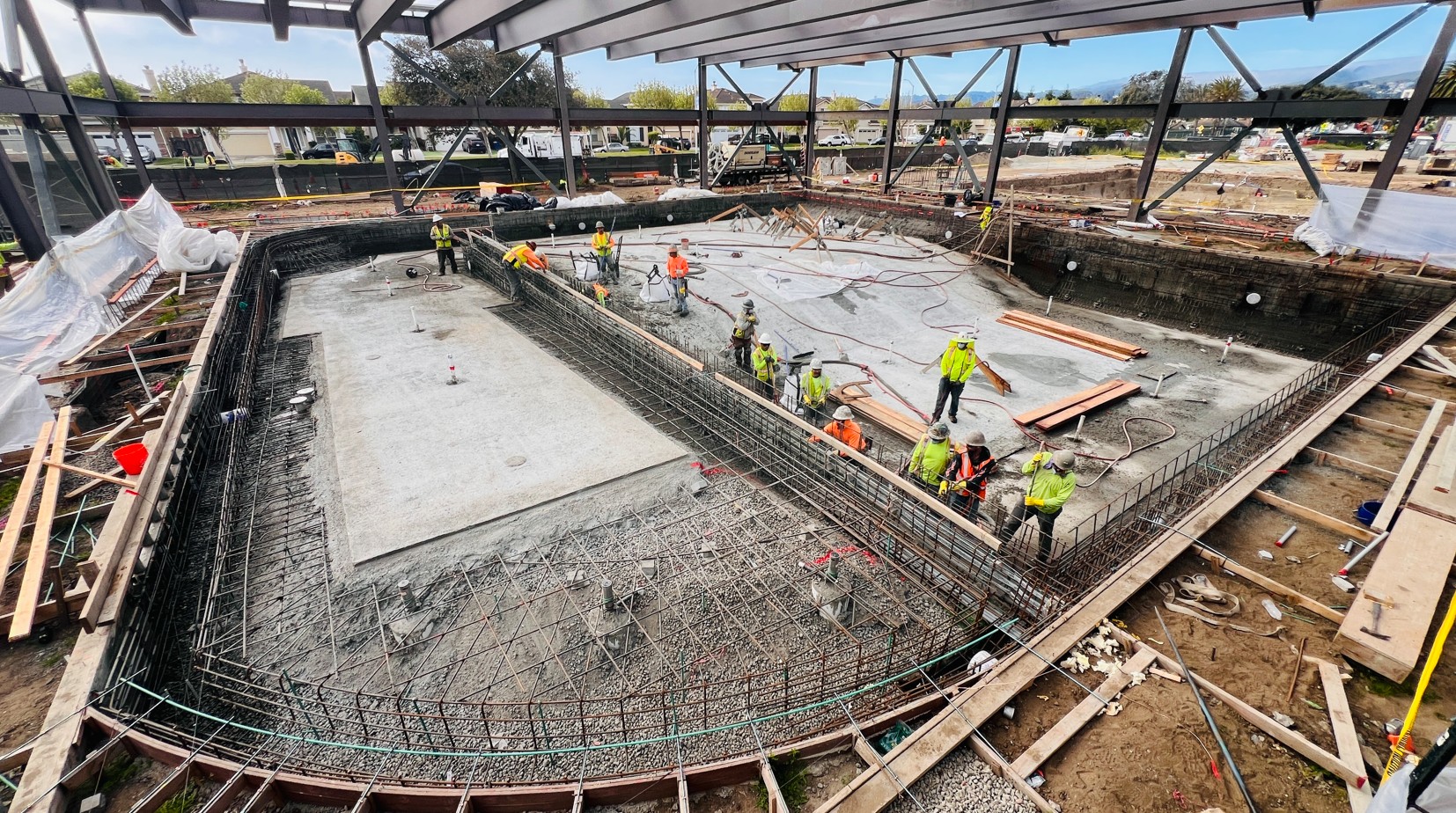

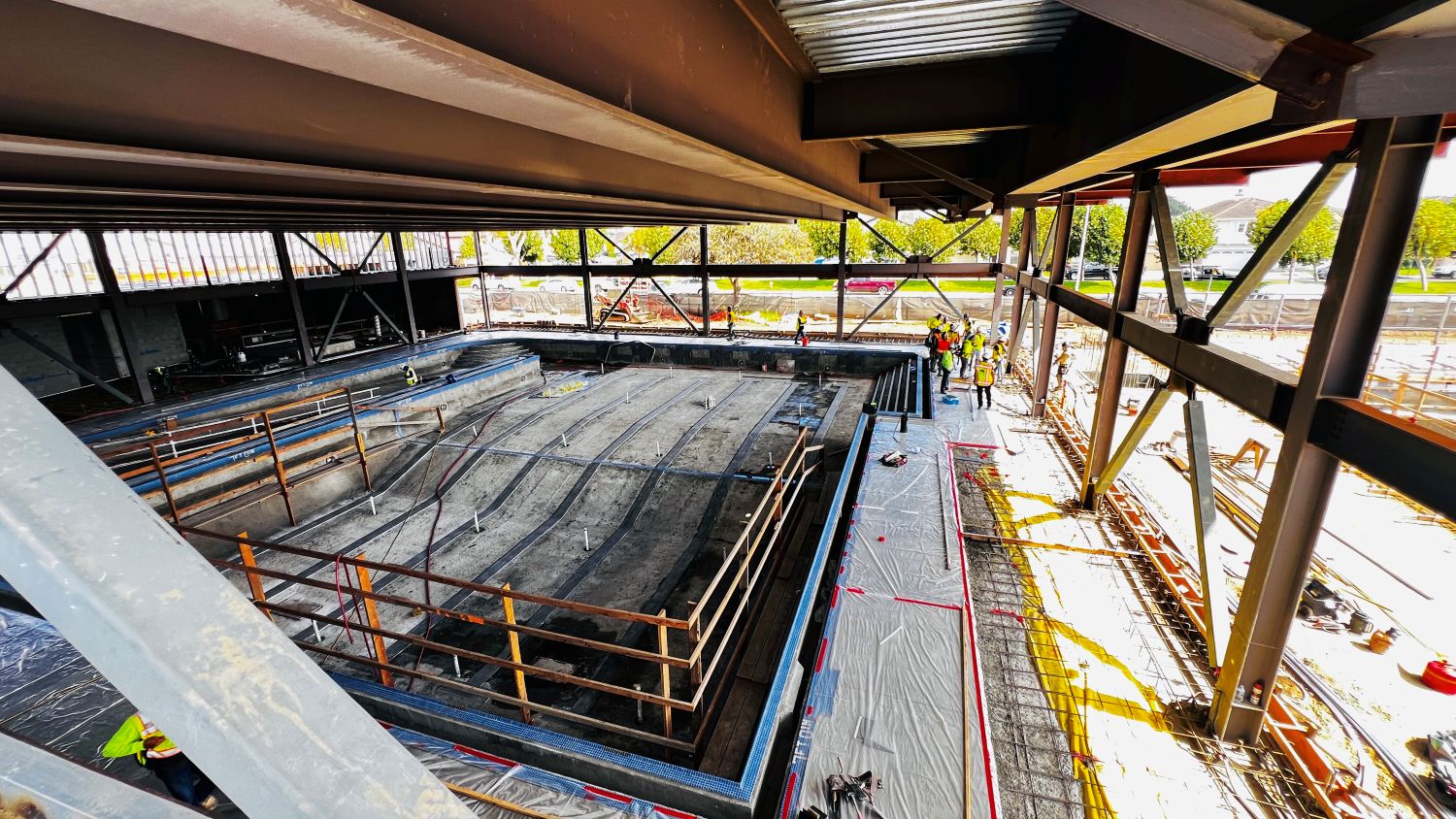

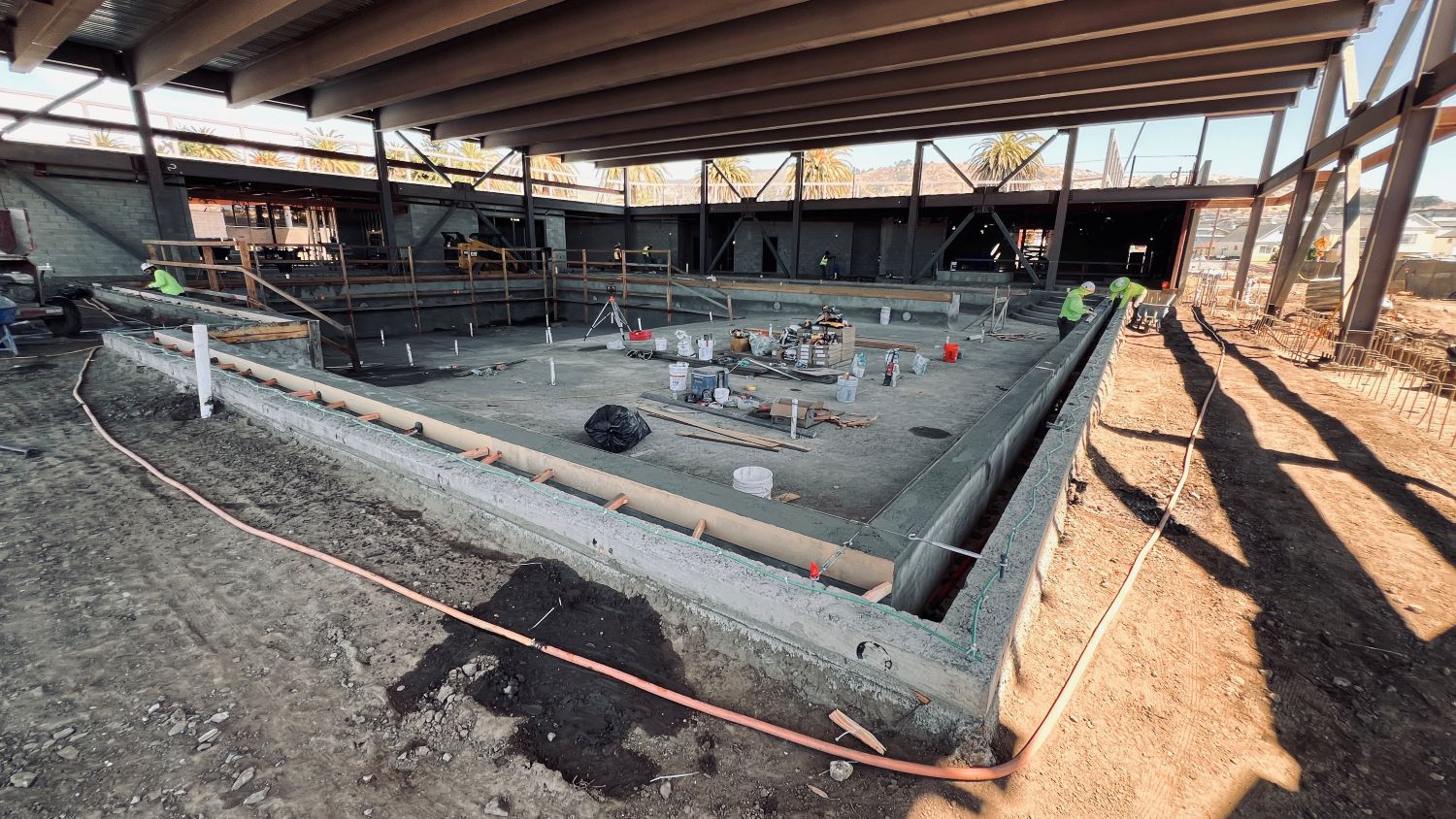

Indoor Pool Deck Completed – On September 10, crews successfully poured the indoor pool deck concrete after completing all underground mechanical, electrical, and plumbing work. This marks a major milestone for the project.

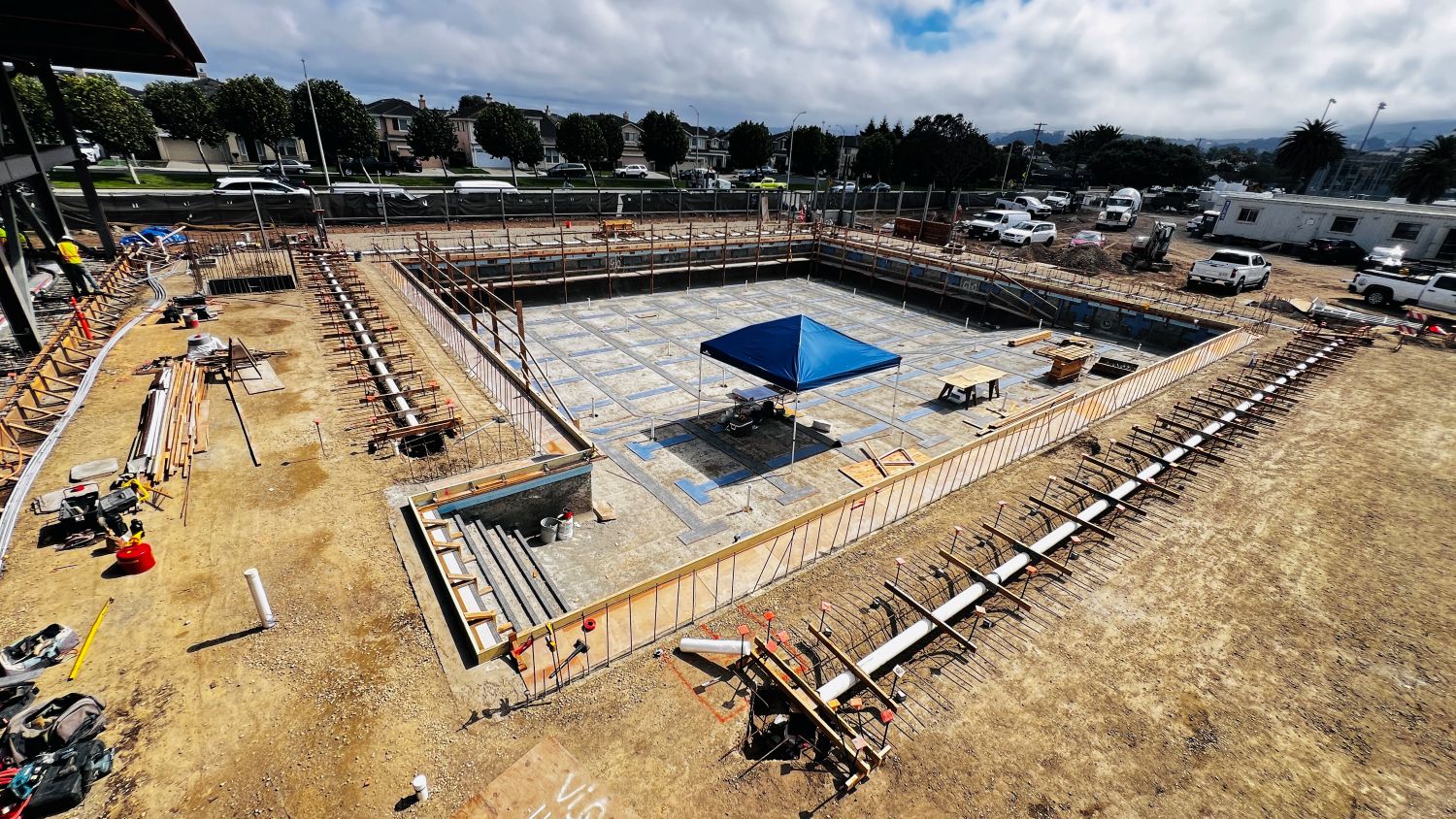

Outdoor Pool Deck Progress – Work is advancing on the outdoor pool area, with rebar installation underway and the slot drain concrete placed this week. The remaining deck pours are scheduled in the coming weeks.

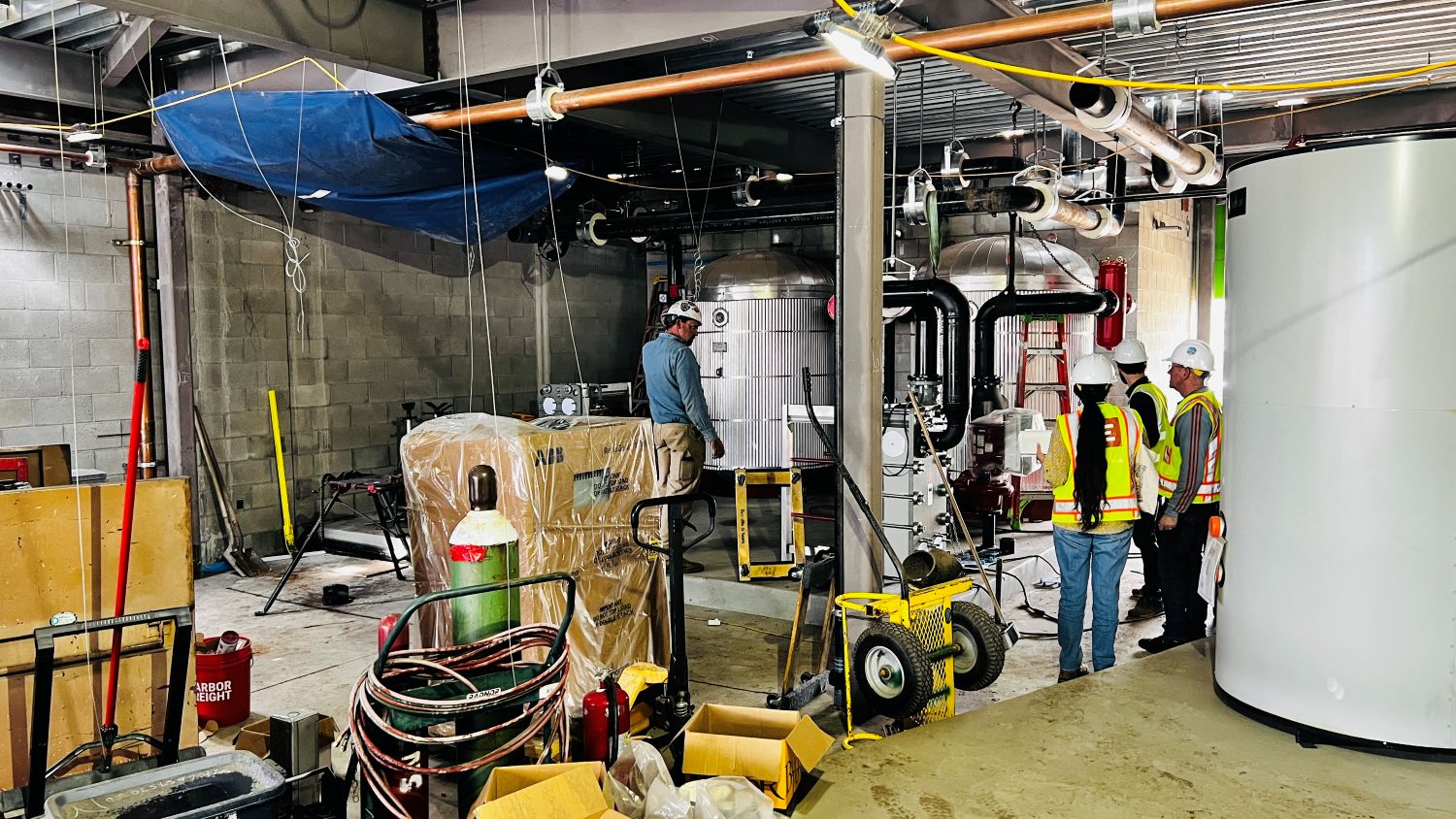

Building Interior Advancements – Crews have continued framing, installing mechanical and electrical systems, and setting equipment in the mechanical room. Rooftop curbs and waterproofing work are also progressing.

Key Inspection Passed – PG&E has approved inspections of the new electrical panelboards, allowing follow-on systems work to continue without delay.
Materials Delivered and Shipping – Several long-lead items are being managed closely. The composite wood siding (Innowood, manufactured in Australia) has shipped and will arrive on site in the coming weeks. Other key items — including lockers, roof waterproofing materials, and major mechanical units — have already been delivered to the jobsite.
Neighborhood Care – Dust and noise control measures remain in place to minimize impacts on nearby homes, while site work continues steadily without interruption to the surrounding community.
Construction Update - 8/6/25
The Orange Memorial Park Aquatic Center continues to make steady progress across key work scopes.

Below-Deck Plumbing and Electrical Infrastructure Installation

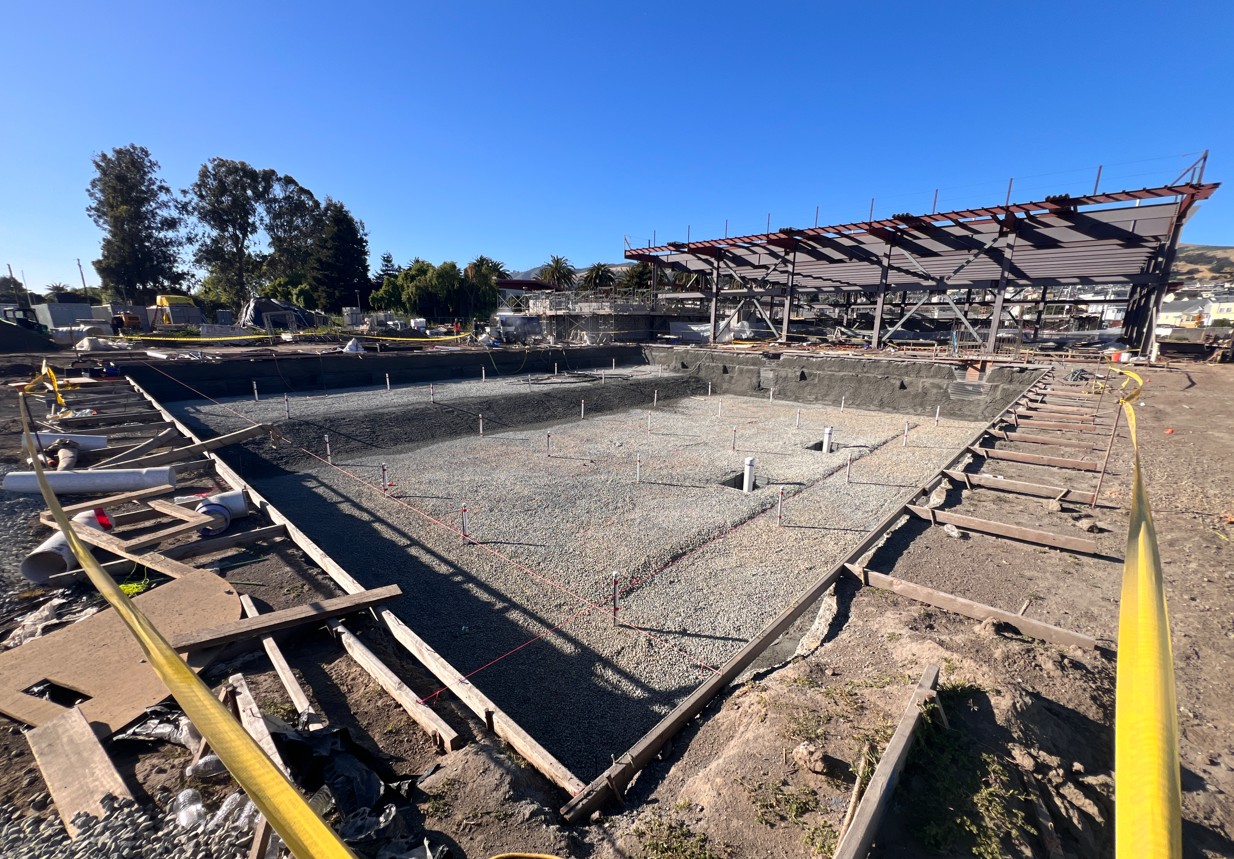

All underground plumbing and electrical work beneath the pool decks has been successfully completed. The work involved installation of essential utilities required to support pool operations and facility services. Following inspection approvals, the area was backfilled and is now prepared for base rock and subsequent concrete placement.

Overhead Fire Sprinkler Installation

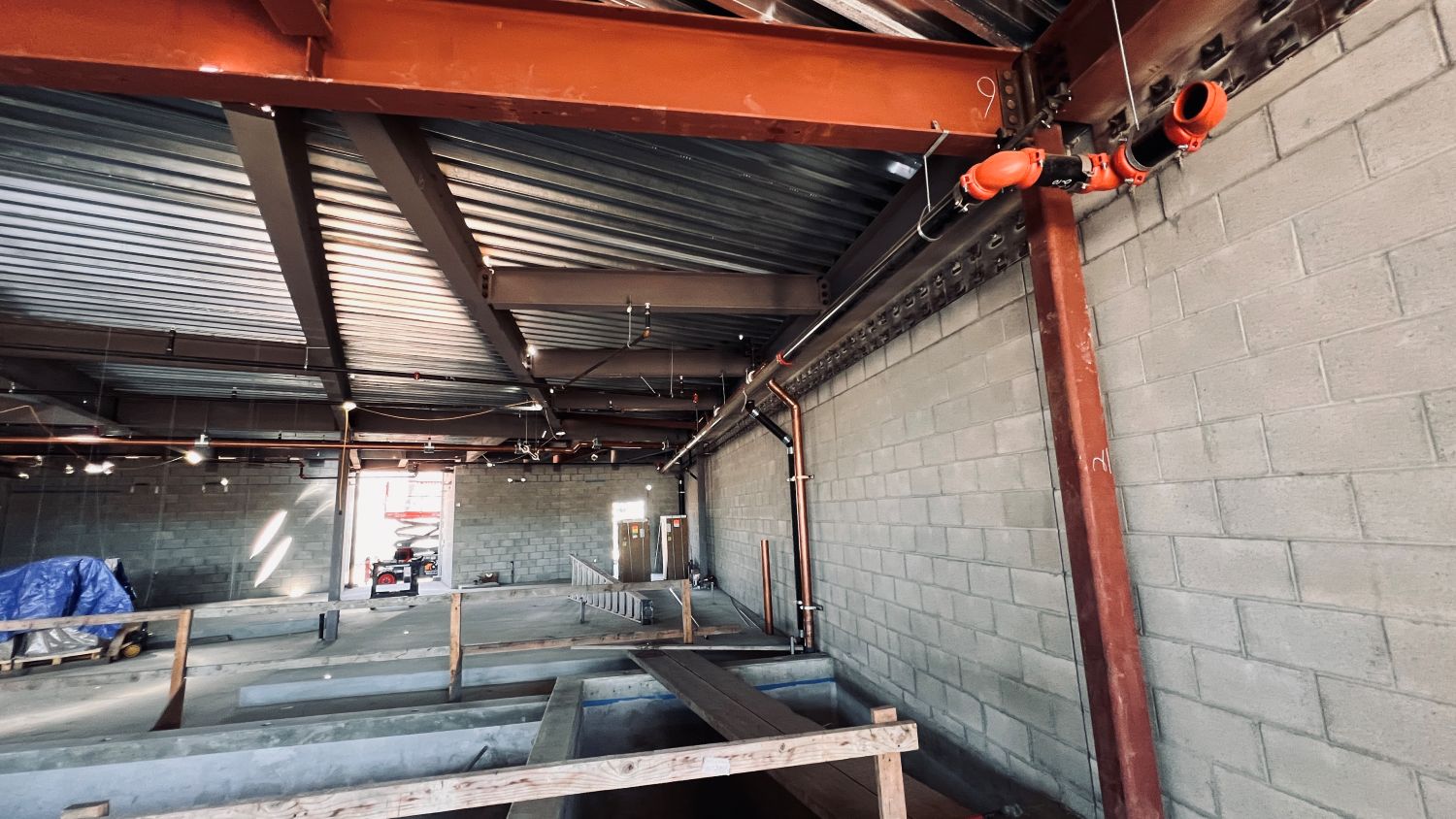

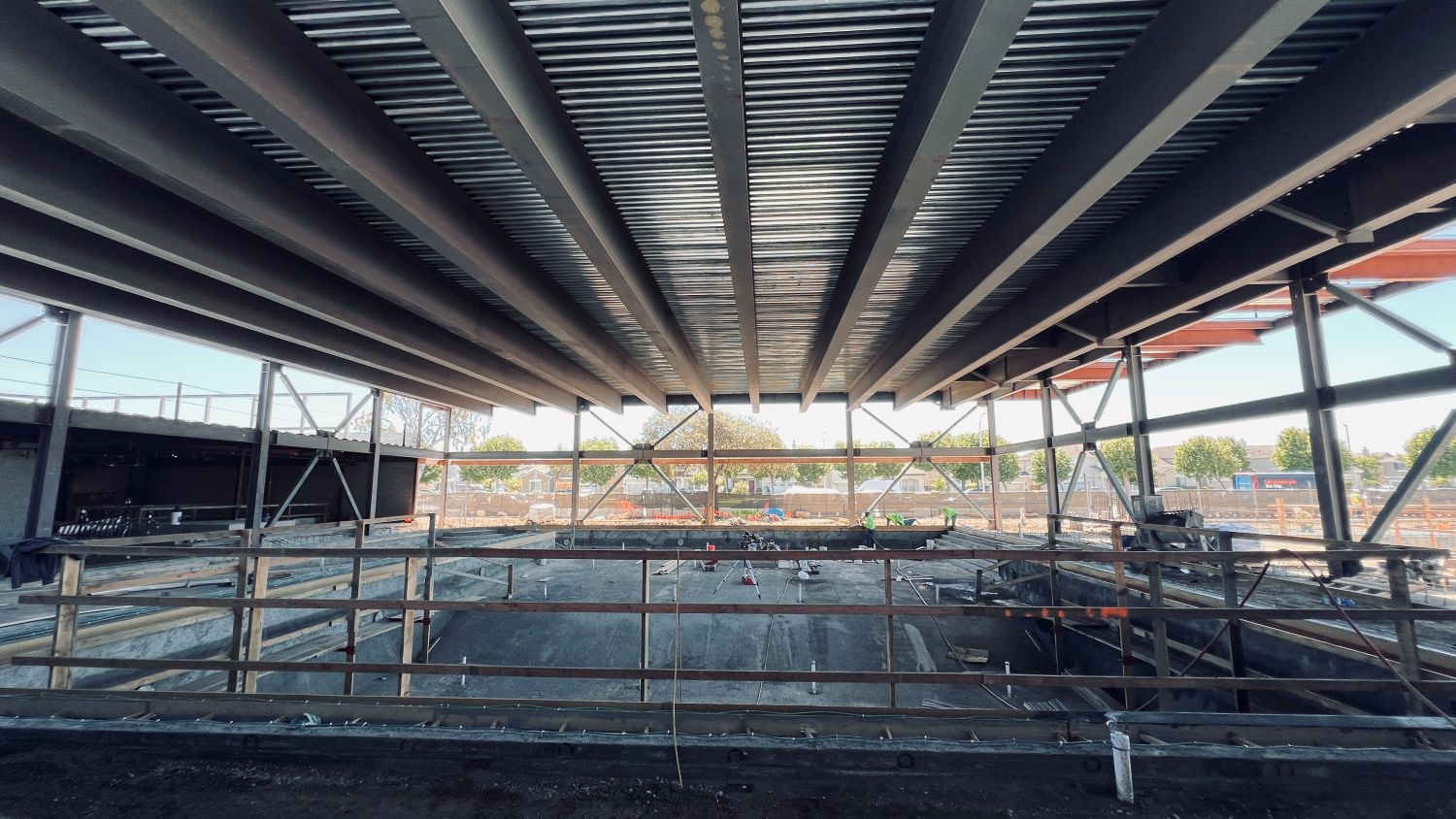

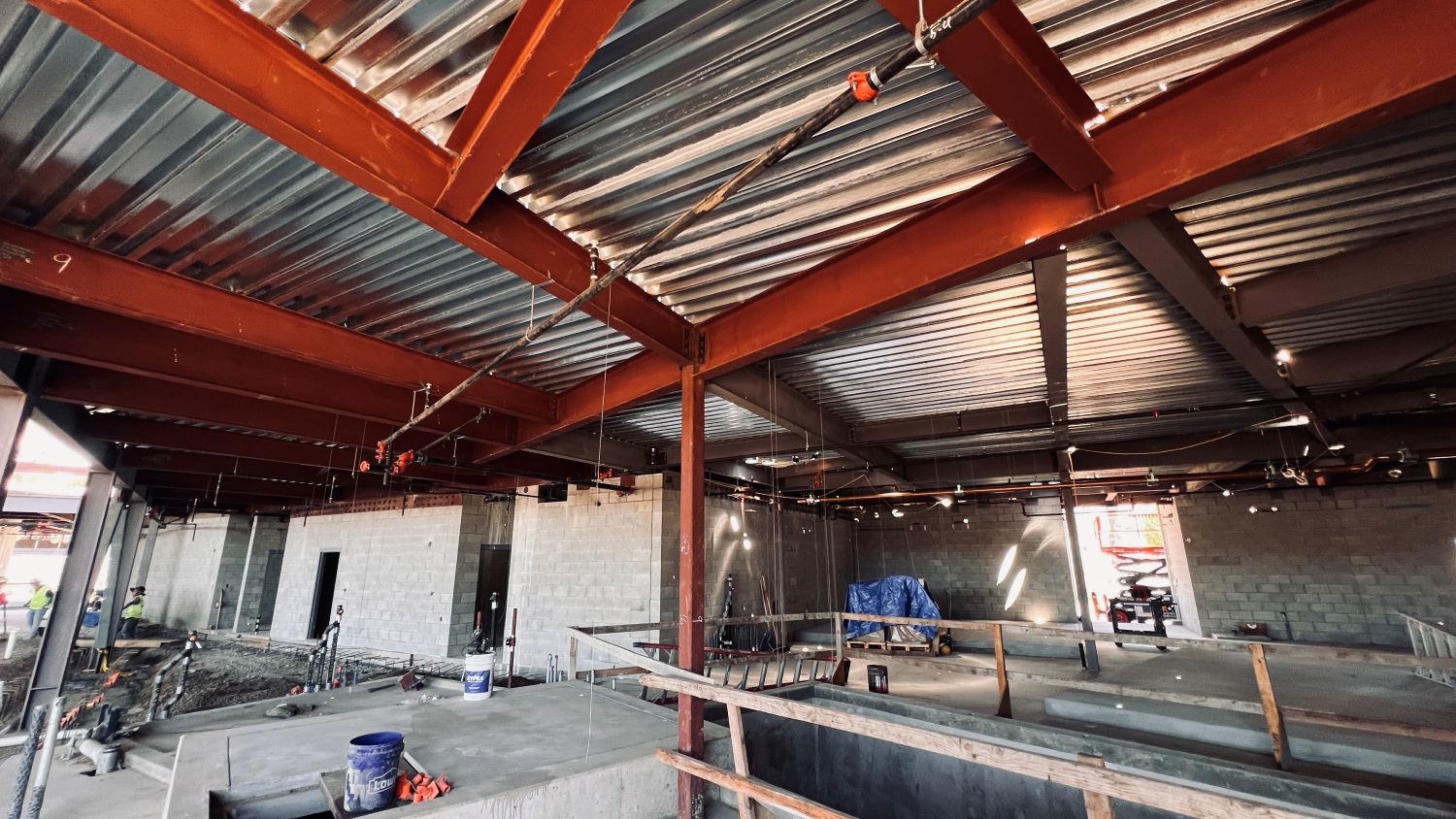

Installation of the overhead fire sprinkler system is currently underway, with approximately 25% of the building covered to date. Work is being performed in coordination with other overhead trades, including HVAC, electrical, and ceiling support systems, to avoid conflicts and ensure proper clearances and local fire code requirements. At this time, no delays or constraints have impacted progress.

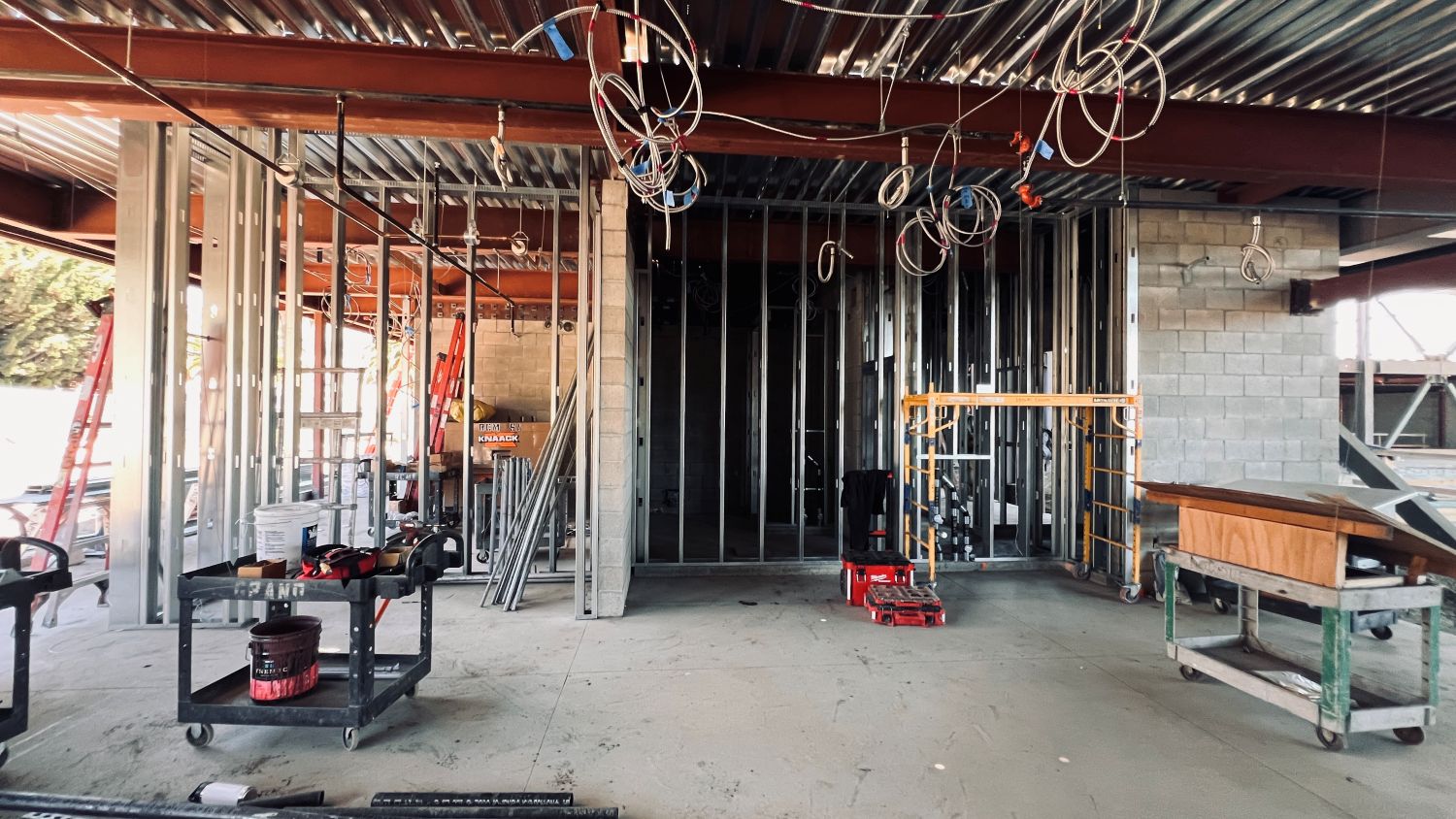

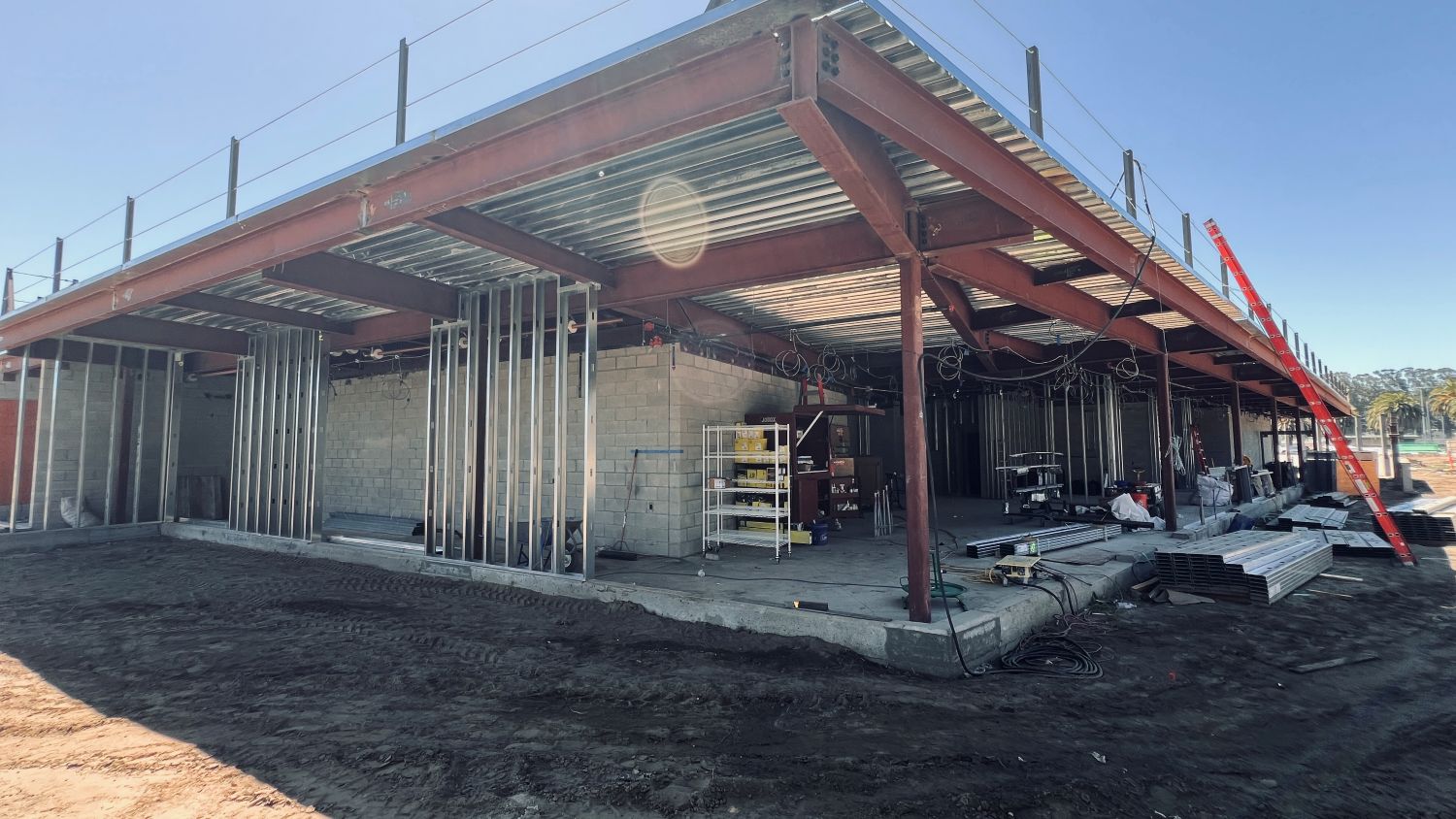

Interior Metal Stud Wall Framing and Drywall

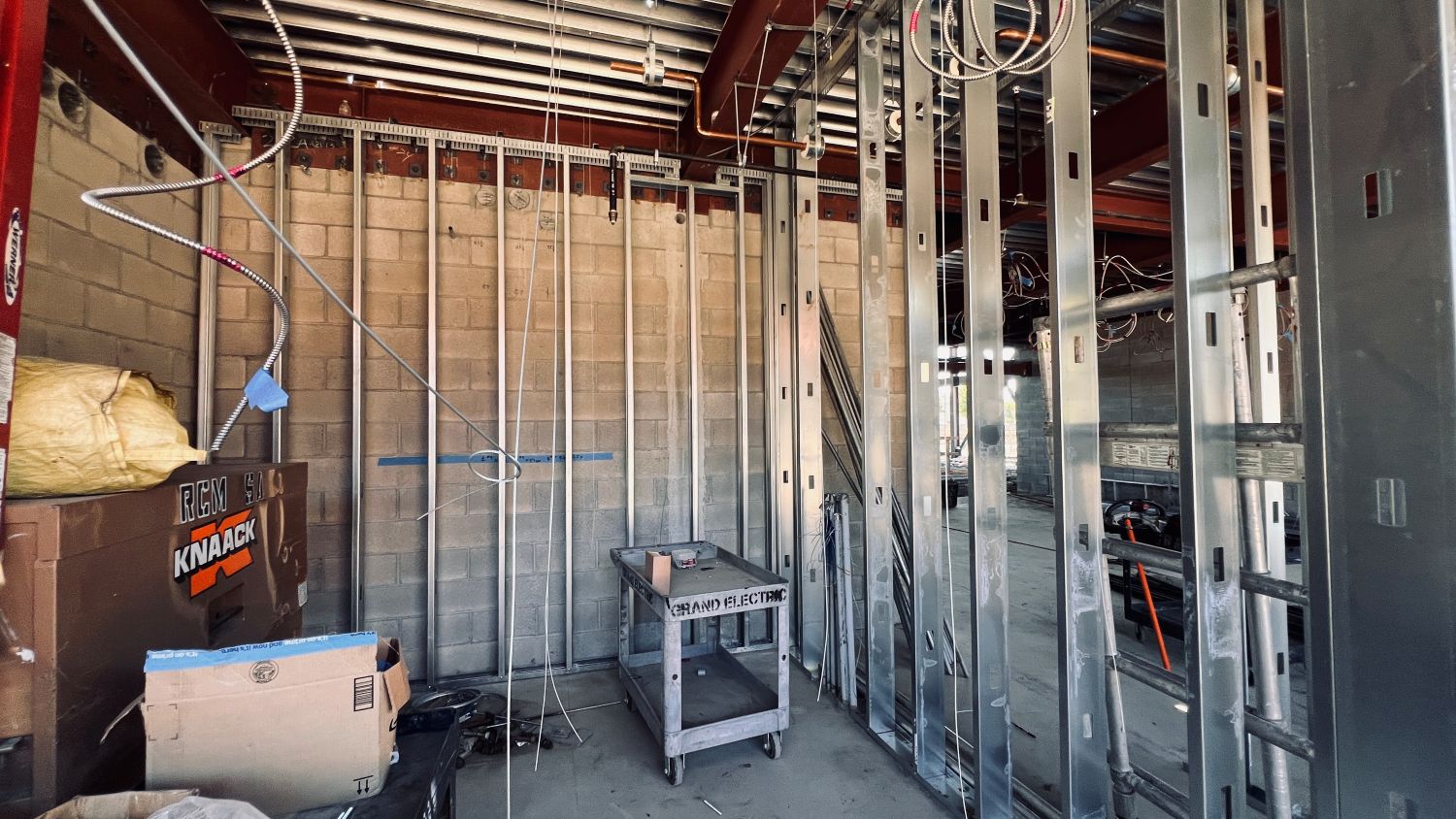

Interior metal stud wall framing is actively progressing across the building, with framing approximately 30% complete. This scope spans multiple interior areas simultaneously, including locker rooms, office spaces, and mechanical rooms. The drywall phase will commence shortly, following completion of framing in each area. Wall layout has been coordinated with embedded utilities, framing tolerances, and door/window opening requirements.

Pool Tile Installation – Outdoor Pool

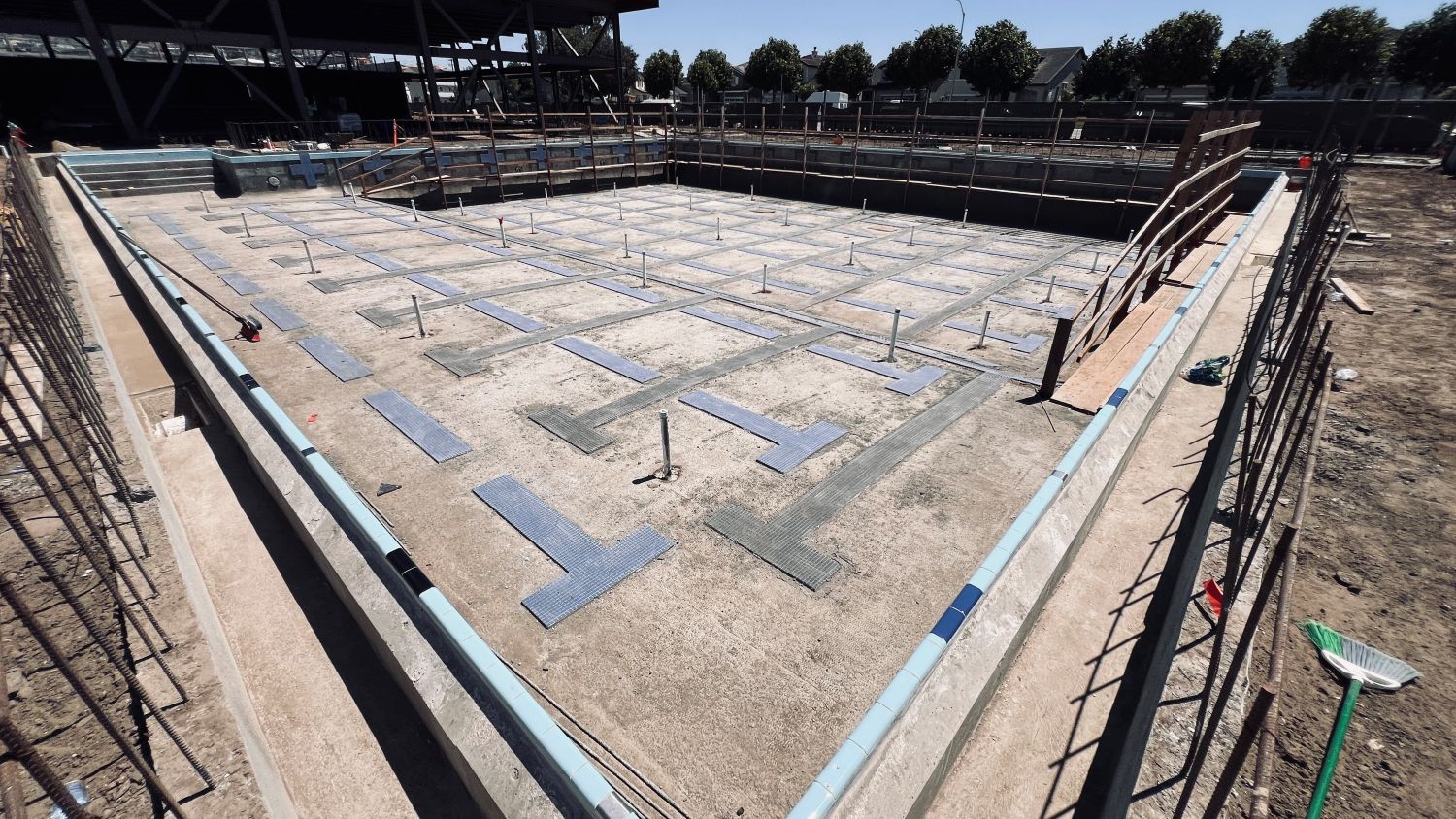

Tile installation has started at the outdoor pool and is approximately 10% complete. The work is progressing steadily and is being carried out in line with the project’s overall design intent. Indoor pool tile installation will begin at a later phase. Care is being taken to ensure a clean, high-quality finish that aligns with the project’s overall aesthetic.

Perimeter Windscreen Framework Construction

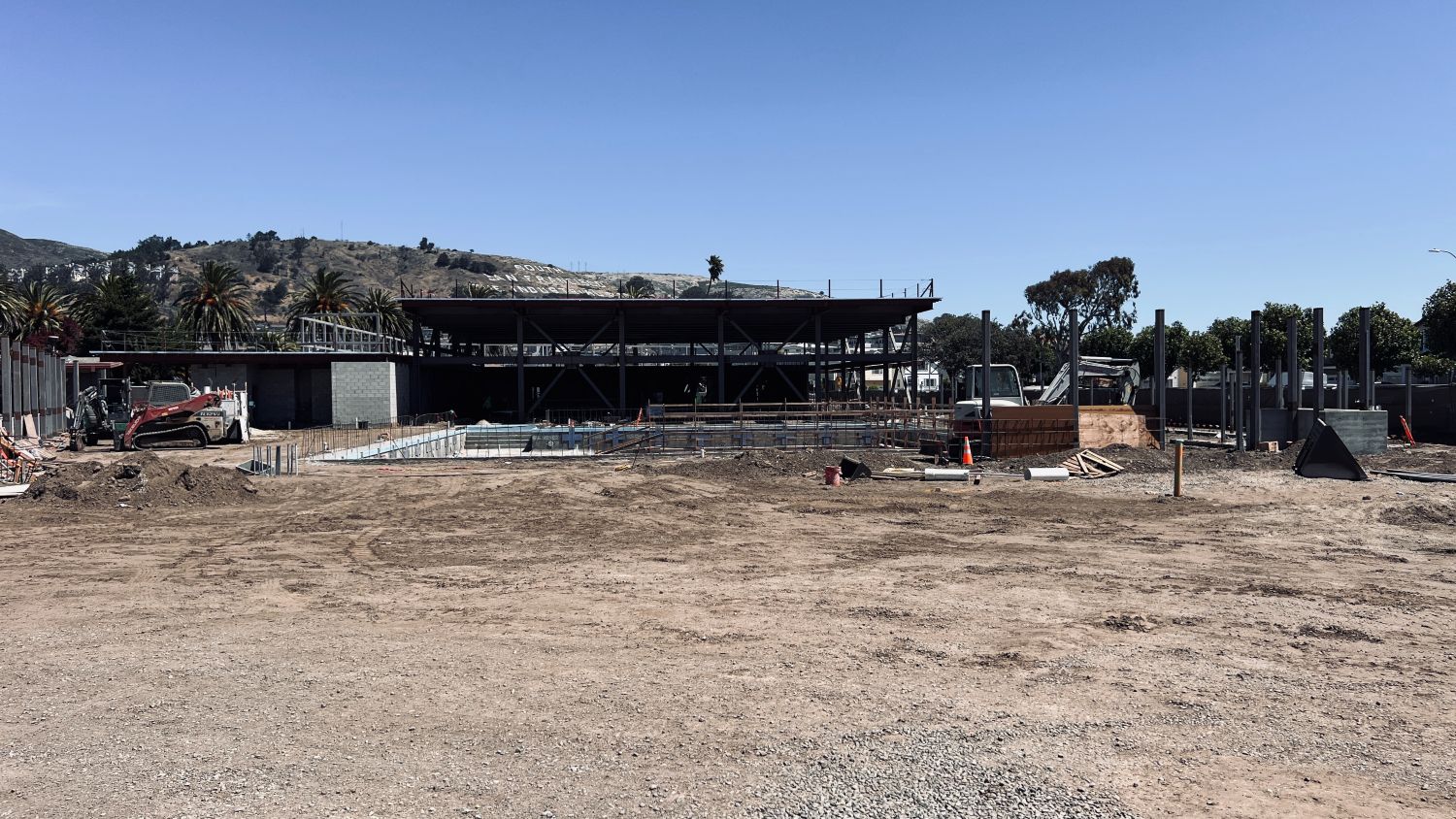

Most of the perimeter windscreen framework has been installed, including structural steel posts and stem walls. Screen panel installation will take place later this summer.

Call For Artists - Deadline 6/10/25
Request for Qualifications – Orange Memorial Park Aquatic Center Mural Project
The City of South San Francisco invites qualified artists or artist teams to submit their qualifications for the design and creation of a public art mural to be located at the Orange Memorial Park Aquatic Center. This project is intended to enhance the visual and cultural identity of the area and foster community engagement.
Project Vision: Originally opened in 1970, Orange Pool is the city's only indoor municipal swimming pool and a year-round hub for recreation, swim instruction, and health programs. In response to overwhelming demand and aging infrastructure, a new aquatic center is being constructed adjacent to the current pool.
The new facility will become a cornerstone of community wellness and engagement. Artists are encouraged to explore themes of community pride, environmental awareness, and playful elements inspired by aquatic or recreational activities in their designs.
DETAILS
- Budget: Up to $50,000
- Submission Deadline: June 10, 2025, or first 250 applicants.
- Location: Orange Memorial Park Aquatic Center, 1 West Orange Avenue, South San Francisco, CA 94080.
- Eligibility: Open to all professional artists and artist teams; preference with those with connections to the San Francisco Bay Area
- Medium: Proposals may include traditional painted works, mosaic installations, or other durable, wall-integrated materials.
- Questions: Regarding this RFQ must be submitted to Ann Berchtold, SSF Public Art
Consultant at aberchtold@migcom.com by June 3rd, 2025 (by 5:00 PM PST)
Applications accepted only via CaFÉ (Call for Entry.org)
To apply, visit https://bit.ly/ACmural_SSF25
For more information on the City’s Cultural Arts Program, visit www.ssf.net/CulturalArts.

Construction Update - 5/20/25

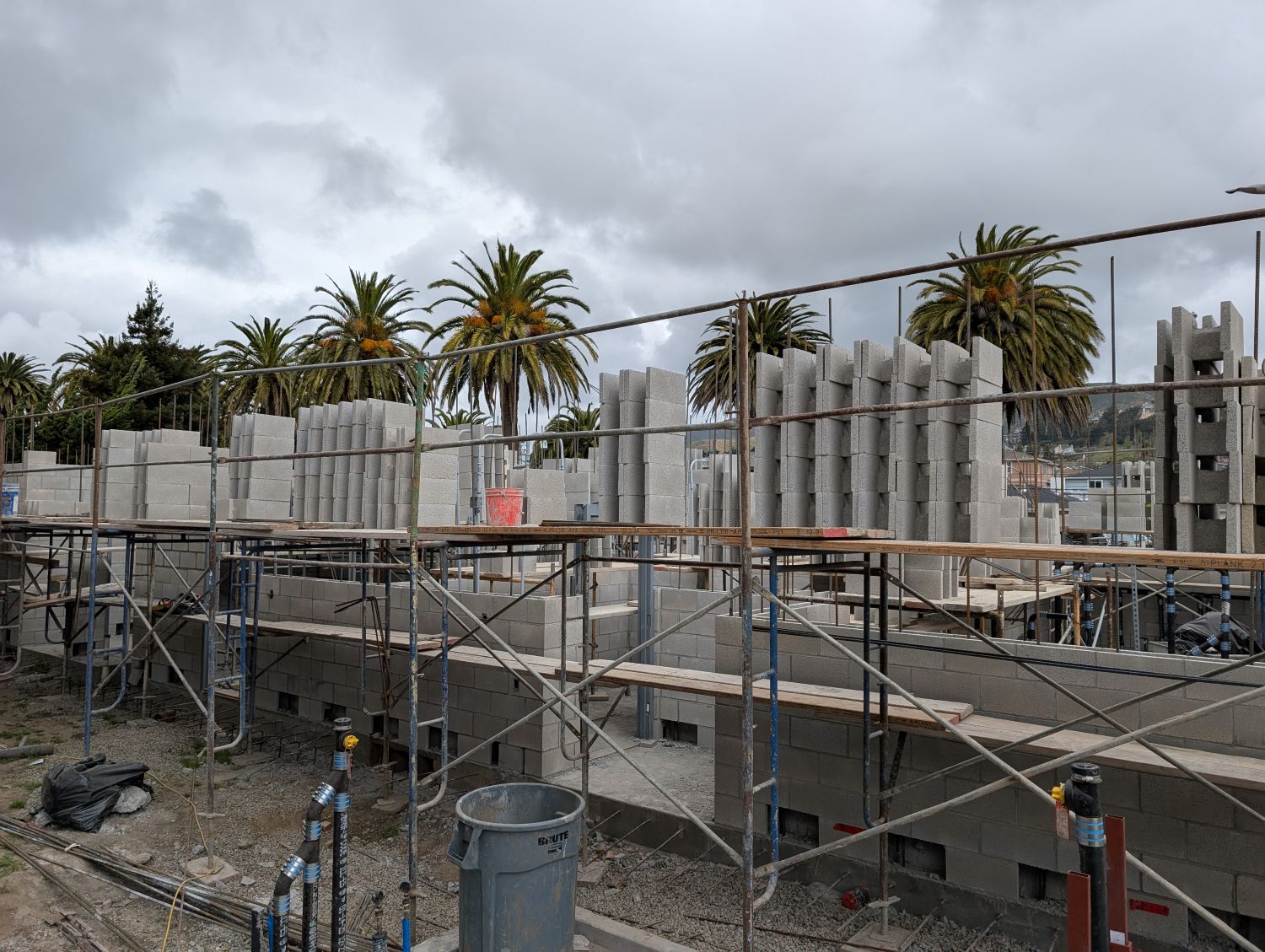

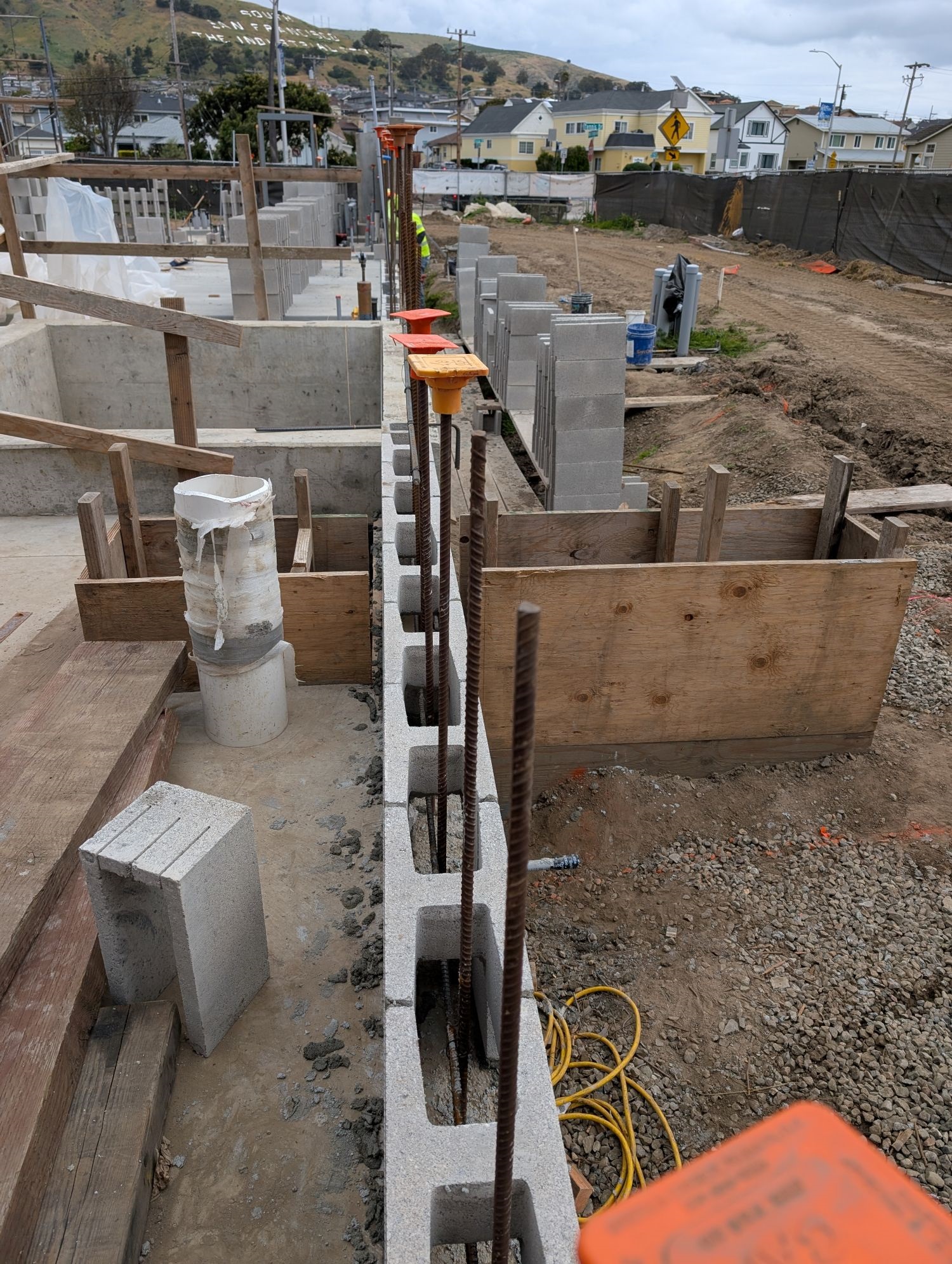

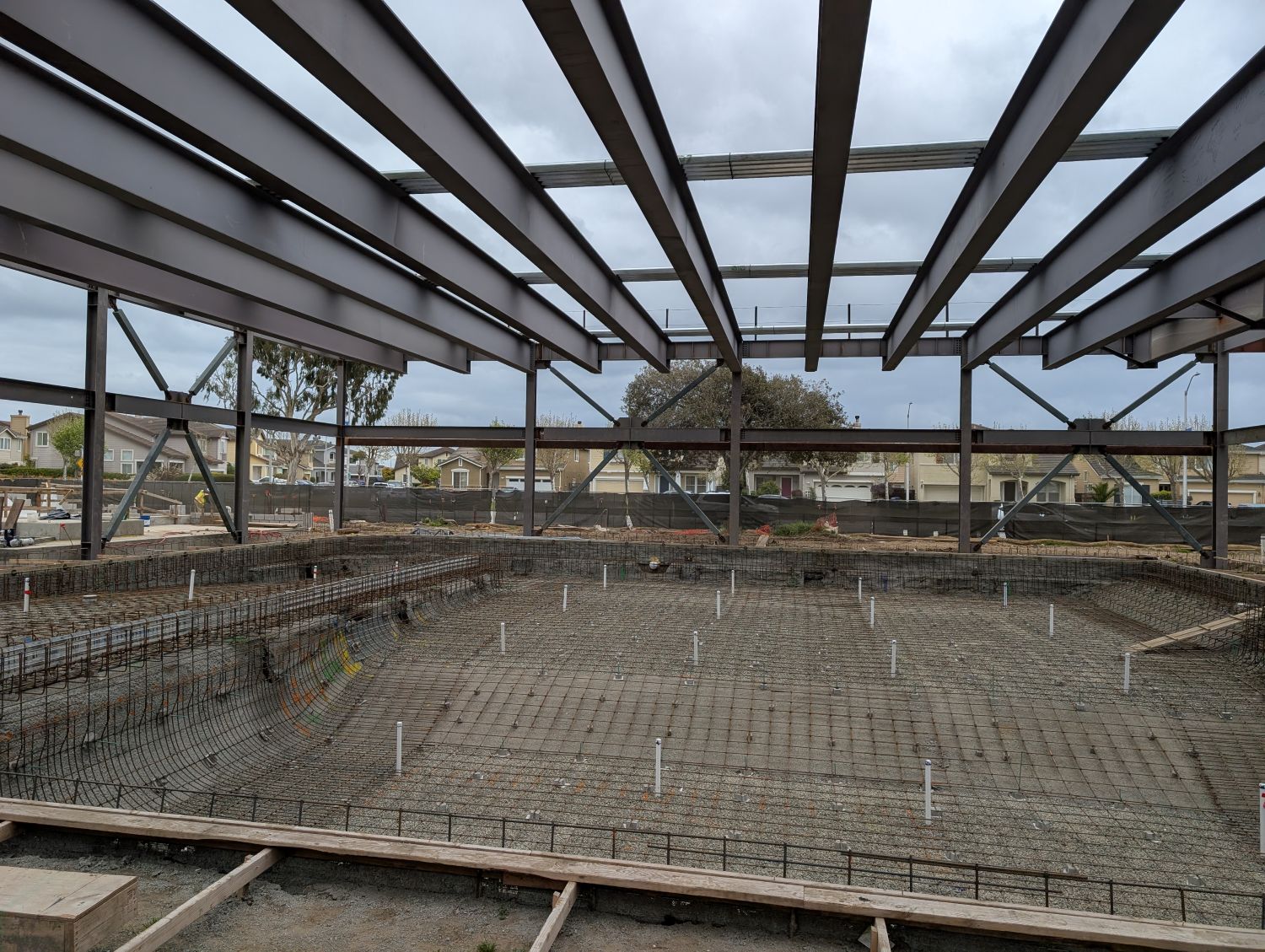

With the completion and curing of the building pad poured end of March and now cured, worked continued with placement of the secondary steel members which will be supporting the roof deck of the building. Assembly of CMU (concrete masonry units) walls to form the locker rooms, office spaces, and activity room took place in early April. The concrete bottoms of both pools were poured and the distribution lines that will deliver both water and chemicals throughout the pool were installed.
Rebar was meticulously installed at the indoor pool to create the form that will hold the water features and support the tile wall that will divide the shallow end of the indoor pool with the larger area for warm water swimming and swimming classes. Rough coats of shotcrete were sprayed onto the rebar to continue to build the structural walls and form of the indoor pool.

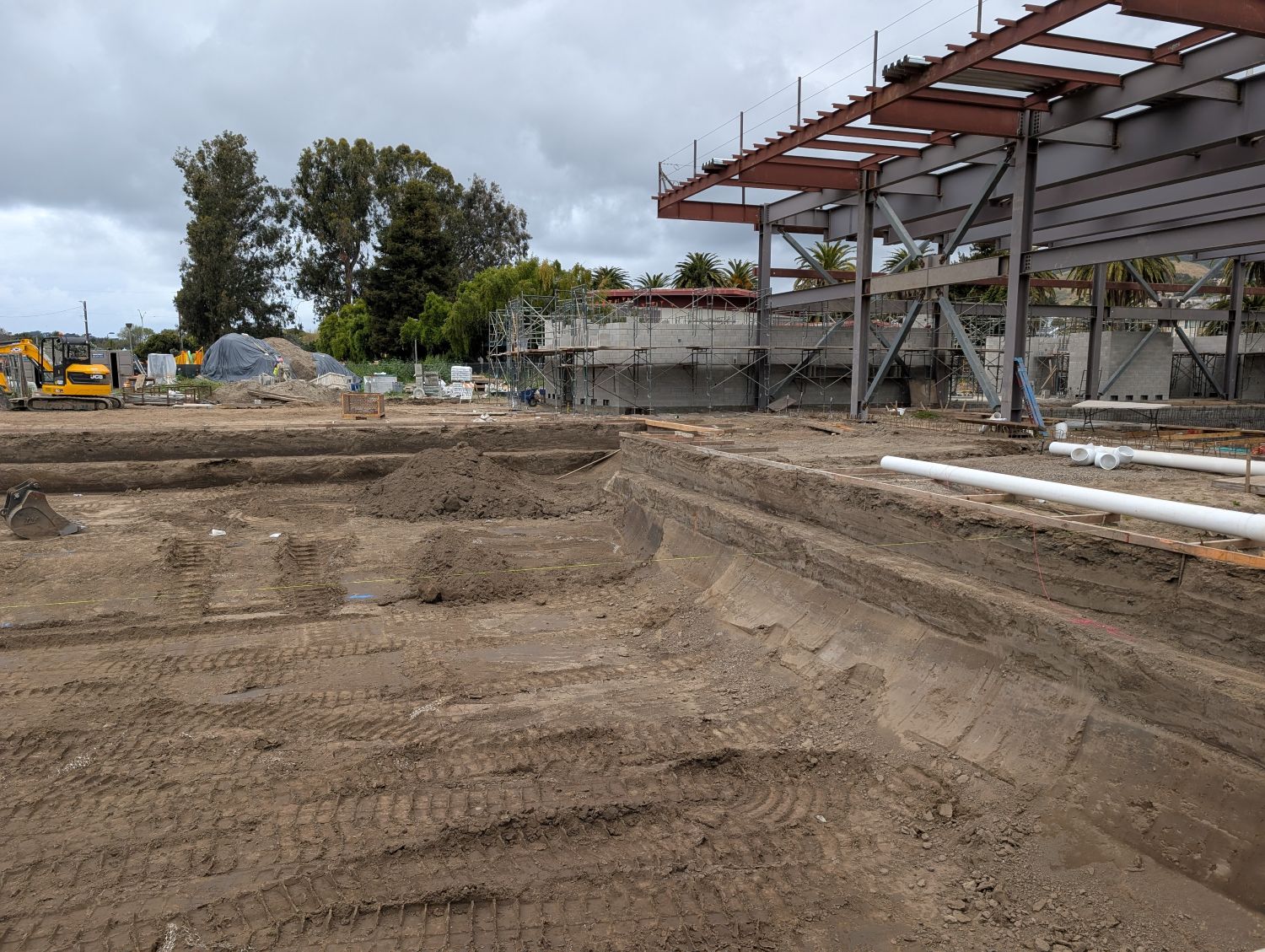

The outdoor pool is following closely behind with the crews moving over to the outdoor pool to begin their work for the rebar to reinforce the walls and sloped sides of the lap pool. All of the underground plumbing for the pools were installed during this period. Key inspections for the pools were passed with approvals from the Health Department for each inspectable milestone allowing us to continue working on both pools in tandem.
Work that will support the building’s functions was also completed with pours completing the mechanical equipment pits and the installation of the settlement vaults for the pools. The overhead steel will soon be painted with a specialty paint that will protect it from the marine environment in which it has been installed.

Early in the month of May, crews performed saw-cutting and connected the site’s storm drain system to the main storm lines at Tennis Drive and Orange Avenue. Painting of the highest steel elements is scheduled for later this month. Cal Water began laying pipes and preparing for the installation of fire hydrants, with work expected to conclude by the end of May. To improve safety of pedestrians crossing from the Tennis Drive Parking Lot to Orange Pool during construction, temporary rumble strips have been installed. A permanent elevated crosswalk with flashing beacon will be constructed later during Phase 1 of the project.
