New Park at Linden Avenue & Pine Avenue

Linden Park

Project Overview

The park at Linden Avenue & Pine Avenue will provide a brand new public space for South City residents to gather, connect, and play. The future park’s design will be determined based on what we hear from the community. The design process will consider temporary, partial or full closure of Pine Avenue to create a connected park space.

Project Fact Sheets (English/Spanish)(PDF, 608KB)

State of California Clean Up Action Report

Environmental Summary Report 616 and 700 Linden Avenue - 2024(PDF, 3MB)
Reporte Ambiental Resumido 616 y 700 Linden Avenue - 2024(PDF, 3MB)

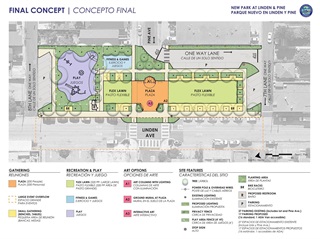

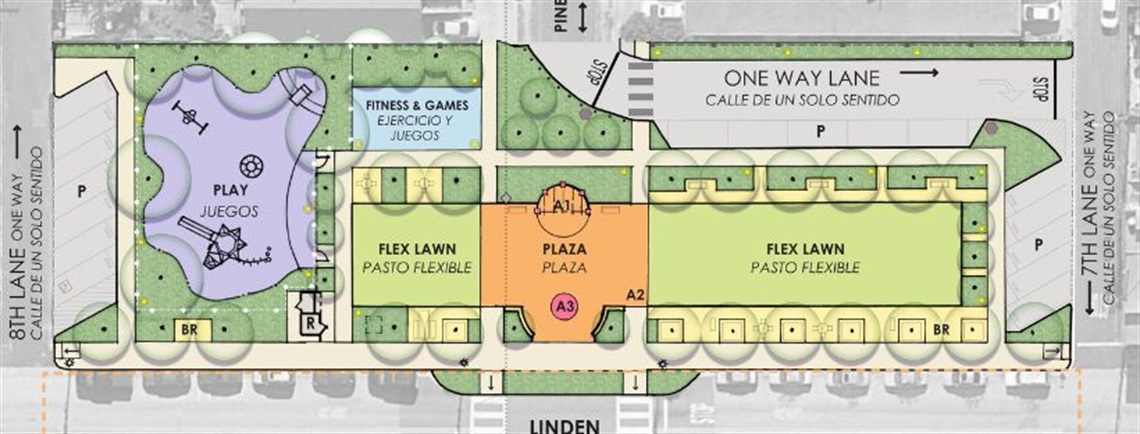

Final Concept Design

Linden Park Final Concept Design

Final Concept Narrative(PDF, 94KB)

Site History

The site's previous use as an automotive repair shop included underground oil and gas tanks. After that closed, the tanks and surrounding contaminated soil were hauled off site and groundwater was routinely tested until the County confirmed it met low-risk requirements. To confirm it was safe to use a park, an environmental consultant was hired to collect soil samples between the surface and 10 feet below grade. No petroleum hydrocarbons were detected, and lead concentrations were below environmental screening levels for residential use. Based on the State’s Low-Threat Underground Storage Tank Case Closure Policy, the soil meets the criteria for direct contact and outdoor air exposure, and the site can be used as a park.

  • 1940s to early 2000s - Volonte Automotive was a repair shop at 616 Linden Avenue from the 1940s to early 2000s
  • 1993 - Gasoline and waste oil underground storage tanks were removed in 1993, and an environmental case was opened and overseen by San Mateo County Groundwater Protection Program
  • 1993 to 2001- 440 cubic yards of contaminated soil were removed from the property and groundwater samples were collected routinely
  • 2001 - San Mateo County closed the case under Regional Water Board guidance for low risk fuel sites in 2001 as it was deemed safe for public use
  • 2023 - Soil testing in June 2023 confirmed it is safe to use the property for a park (based on State policy for former gasoline stations)

Project Budget

The total project budget for design and construction is $5.5 million.

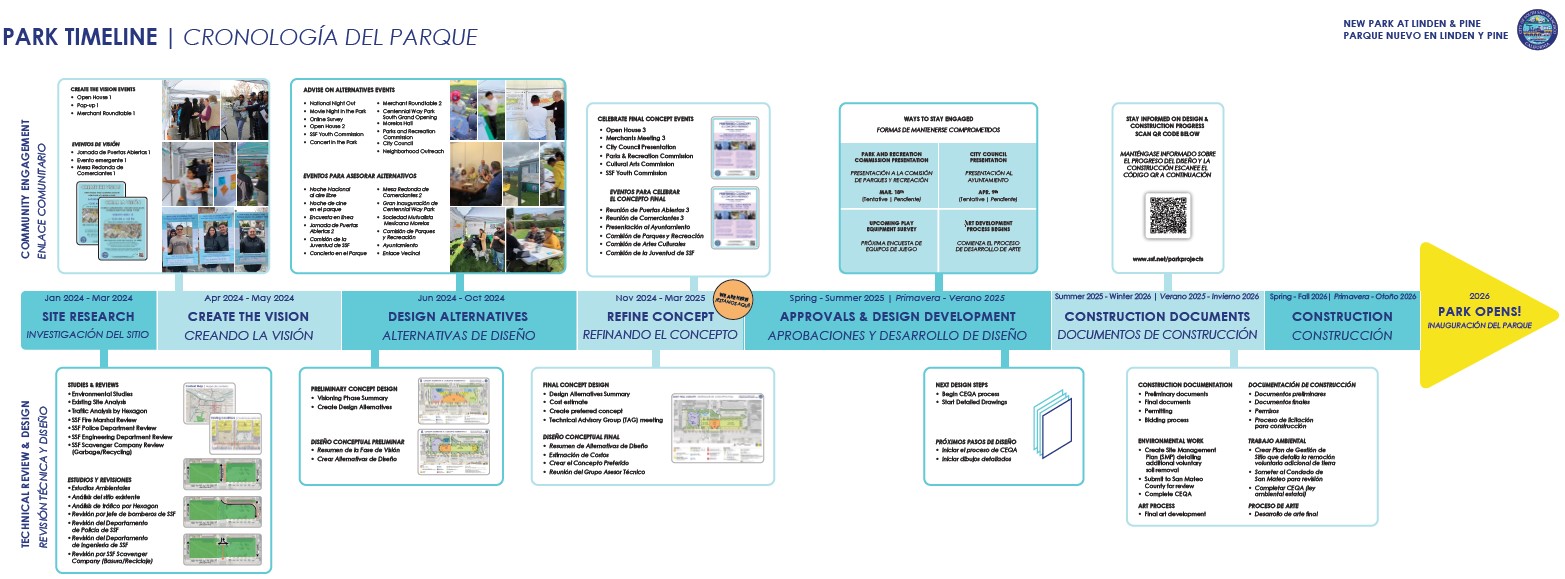

Proposed Schedule

Project Updates

Traffic Changes - 8/10/26

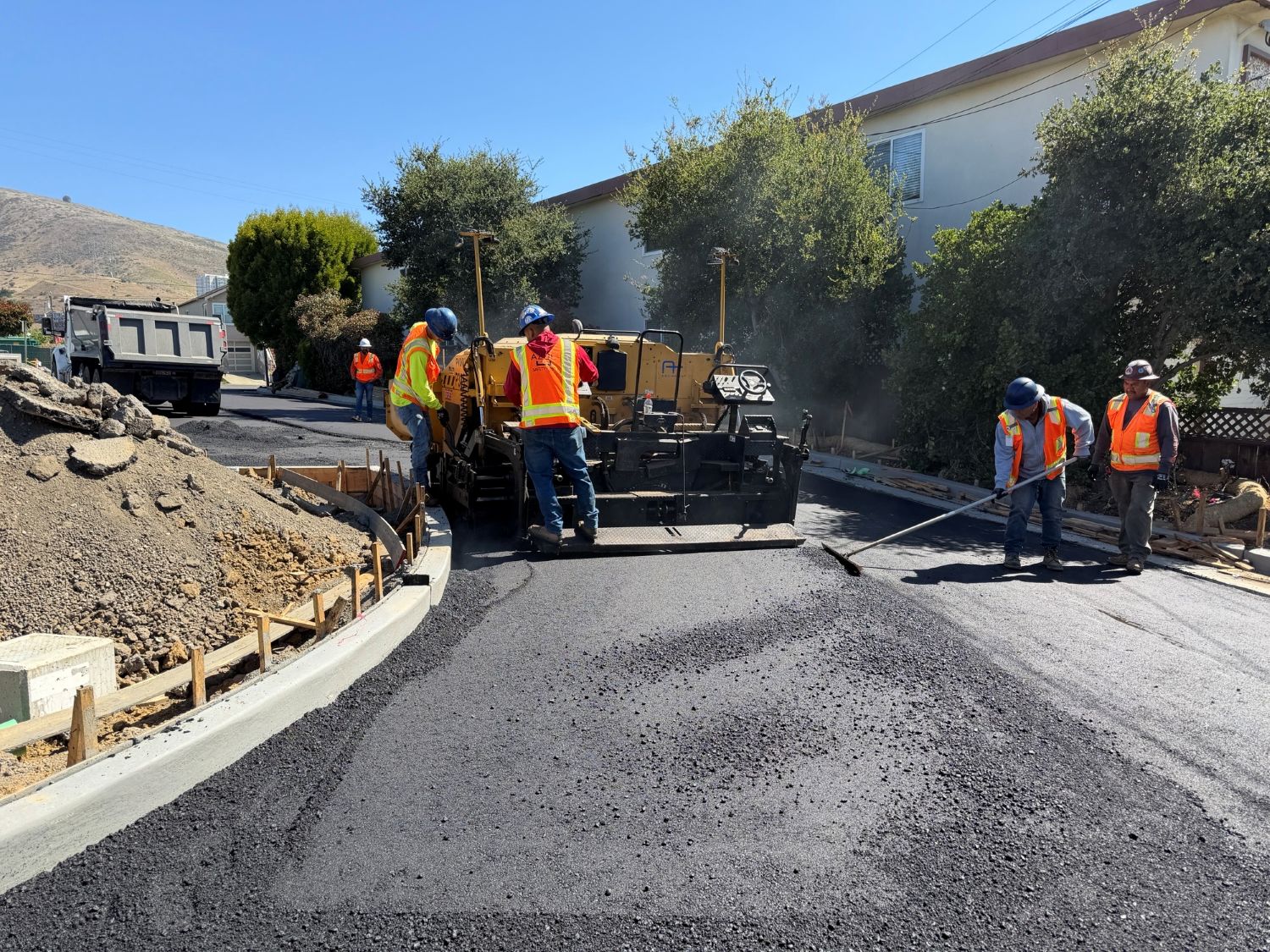

Construction Update: Pine Avenue Traffic Changes Begin August 10

Construction of the New Park at Linden and Pine Avenue continues to make steady progress, with the project reaching its first major milestone.

Beginning Monday, August 10, the new Pine Avenue Extension will open to vehicle traffic. Since construction began in early June, crews have focused on building the new roadway, including curbs, gutters, and pavement. The opening of the extension marks an important step forward in the project.

Pine Avenue Closure

Following the opening of the extension, a portion of Pine Avenue between the 616 and 700 Linden Avenue parcels will be closed to both vehicle and pedestrian traffic to allow construction of the park's central plaza and other park features.

During this phase:

  • Westbound traffic on Pine Avenue will be detoured to Linden Avenue via the new Pine Avenue Extension and 7th Lane.
  • Construction fencing will connect the 616 and 700 Linden Avenue parcels, creating a secure work area for park construction.
  • The sidewalk along Linden Avenue will remain open for pedestrians.

We appreciate the community's patience and understanding as construction continues.

Linden & Pine Park traffic changes map

road construction road construction

road construction road construction

newly paved road newly paved road

Groundbreaking - 5/8/26

You are invited to the groundbreaking!

Friday, May 8, 2026
10:00 a.m. - 11:00 a.m.
700 Linden Ave, South San Francisco, CA

New Park at Linden & Pine Ave Groundbreaking

Join us for the groundbreaking of a new neighborhood park and cultural plaza in Old Town, bringing much-needed open space to the community.

This project will transform 616 and 700 Linden Avenue and a portion of Pine Avenue into a vibrant place for all to enjoy, made possible through State and Federal grants and South San Francisco Park Development and Acquisition Fee Funds.

Construction Contract Before Council - 4/8/26

Construction of the New Park at Linden and Pine is moving closer to breaking ground.

At the upcoming City Council meeting on April 8, staff will recommend awarding a construction contract to Azul Works, Inc. for development of the new park. See meeting details, including ways to provide public comment.

If the contract is approved, a groundbreaking event is anticipated in early May, with construction beginning shortly thereafter. The project is expected to continue through 2026, with the park opening projected for early 2027.

City Council Agenda 4/8/2026

Archived Updates - 2025

Public Art Survey - 10/24/25

Help Choose Art for the New Park

The New Park at Linden and Pine Avenue will have three integrated mosaic art components consisting of four sculptural mosaic columns, a pavement mosaic inlay, and a mosaic clad playground sculpture.

Take the Survey
Survey closes on Friday, October 24, 2025.

Final Artist Selection

The Cultural Arts Commission is tentatively scheduled to select the final artist at the regular meeting on November 25th, beginning promptly at 6:30 p.m. Community members are welcome to attend.

For more information, please visit www.ssf.net/culturalarts.

Environmental Review

The Initial Study and Mitigated Negative Declaration (IS/MND), prepared under the California Environmental Quality Act, will be available for public review and comment starting in mid-September.

  • Online: Documents here
  • In person:
    • Planning Division – 315 Maple Street, South San Francisco, CA 94080
    • Grand Avenue Library – 306 Walnut Avenue
    • Library | Parks and Recreation Center – 901 Civic Campus Way
    • City Clerk’s Office – 400 Grand Avenue

Public Art at the Park - 10/4/25

Public art will play a major role in creating a unique identity for the park. The City invited artists to submit qualifications for three mosaic-based works:

  • Four sculptural mosaic columns
  • A pavement mosaic inlay
  • A mosaic-clad playground sculpture

The City received 34 submissions, with 4 finalists selected by the Cultural Arts Commission’s subcommittee.

Community Art Preview Event
Saturday, October 4, 2025
10:00 a.m. – 12:00 p.m.
700 Linden Avenue

Help us make sure the art for this site represents you and your community! Come view the artists’ concepts, meet the finalists, and share your feedback. Designs will also be posted on this project page. Input from the community will guide recommendations to the Cultural Arts Commission.

Linden Park Community Art Concepts Reveal

See event flyer: English(PDF, 4MB) | Spanish(PDF, 3MB)

Restroom Facilities Pilot Program - 9/29/25

man entering throne with phone

Based on overwhelming feedback from community members, the park design allows for either a prefabricated single-stall restroom or space for a portable restroom. To help determine the best long-term option, the City is partnering with Throne Inc. to pilot a subscription-based portable restroom in order to test if users might consider this a preferred option at this location.

The Throne restroom will be temporarily located at Linden Avenue and 8th Lane beginning September 29, 2025. Features include:

  • Flushing toilet & running water sink
  • Climate control
  • Baby changing station
  • Sharps container
  • Graffiti-resistant wrap
  • 24/7 remote monitoring

The Throne restroom will be free to use, with access available by text message, mobile app, or an access card. During the pilot, residents may pick up a free access card at Grand Avenue Library (306 Walnut Avenue). For more information about Throne, see the Frequently Asked Questions in English or in Spanish.

community survey will launch in early October. Survey results and anonymous usage data will help the City decide whether to continue with a Throne subscription when the park opens, or to construct a permanent restroom.

Play Survey Results

We had a solid response to the survey—with 87% of responses from Old Town residents. Based on your input, the playground will feature a Multi-Kid Spinner, Group Swing, Tot Slide, Natural Edges, and a Climbing Structure. Option B was the community favorite for its inclusive design, vibrant color, and variety of play activities. Top picks included the Spiral Net, Double Slide, and Monkey Bars. We also heard strong support for using safe and durable materials and amenities like restrooms and a drinking fountain.

front and back of playground structure rendering

Call For Artists - Deadline 7/18/25

Request for Qualifications - Linden and Pine Park | Columns, Mosaic Inlays & Playground Sculpture

The City of South San Francisco invites qualified artists or artist teams to submit their qualifications for the design and creation of a cohesive suite of site-specific mosaic artworks at the new Linden and Pine Park. The commission will include three integrated mosaic components: four sculptural mosaic columns, a pavement mosaic inlay, and a mosaic-clad playground sculpture. One artist or artist team will be selected to ensure the artworks are conceptually and aesthetically unified.

This project is envisioned to enhance the park’s visual identity, serve as a backdrop for performances and community gatherings, and foster a strong sense of place through a site-responsive mosaic design.

DETAILS

  • Location: New Park at Linden and Pine,  616/700 Linden Avenue, south San Francisco, CA 94080
  • Budget: Total combined cost NOT TO EXCEED: $168,000.
  • Submission Deadline: July 18, 2025 (by 5:00 PM PST) or first 250 applicants
    All materials must be received by July 18, 2025. Late submissions will not be considered.
  •  Eligibility: Open to all professional artists and artist teams.  Preference will be given to artists with a demonstrated connection to South San Francisco or the greater Bay Area.
  • Medium: Artists working in all mediums appropriate for this installation are encouraged to apply.

Questions contact:
Ann Berchtold
SSF Public Art Consultant
aberchtold@migcom.com
Deadline for Questions: July 10, 2025

City Council Preferred Concept Presentation - 5/14/25

The preferred concept design was presented to City Council on April 14. Councilmembers expressed overall support for the concept, while raising questions regarding parking time limits and emphasizing the importance of continued outreach to nearby residents and businesses about potential construction impacts. The Council also supported the inclusion of a public restroom, requesting additional details on the Throne submission option, and data supporting the need for a single-stall permanent facility.

In early June, the project team will release a community survey to gather input on playground equipment. The options will reflect features prioritized during previous outreach efforts but will offer varied configurations and design styles for feedback.

Preferred Concept Presentation(PDF, 3MB)

Parks and Recreation Commission - 3/18/25

Parks and Recreation Commission – Preferred Concept Presentation

City staff and the design team presented the preferred concept design, including feedback from recent engagement activities along with an overall project update.

Preferred Concept Presentation(PDF, 3MB)

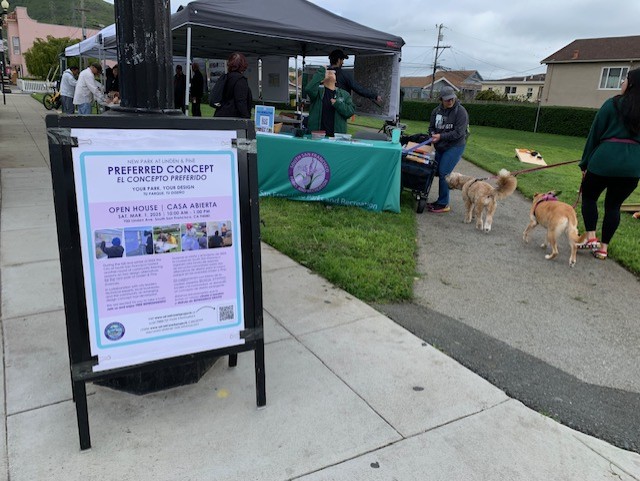

Open House Event 3 - 3/1/25

City staff and the design team hosted an Open House at 700 Linden Ave. the morning of Saturday, March 1 where attendees were walked through the concept design and project timeline. Input was gathered to inform themes and style for public art in the park. The meeting was well attended by neighbors and local merchants.
General Feedback:
  • Visitors and nearby business owners are excited to have a new community space in the neighborhood.
  • Overall happiness for the kids to have a new playground in walking distance.
  • Looking forward to improved facilities such as the restroom and more seating opportunities.
  • Questions & concerns relate to soil quality, traffic and park operations (parking enforcement, safety, security).

Open House 3 Boards(PDF, 17MB)

Archived Updates - 2024

Design Alternatives Phase Summary

Thank you to all who participated in the Open House + Listening Session, Pop-Up Event, Merchants' Round Table and provided feedback through the survey during the Design Alternatives Phase for the new park at Linden and Pine. A summary of these engagement activities and feedback gathered is available below. The next phase of engagement and design will kick off in early 2025.

Design Alternatives Summary(PDF, 8MB)

City Council Project Update - 10/23/24

At the October 23rd SSF City Council meeting, City staff and the design team presented an update on the community engagement and design process so far for the new park at Linden and Pine Avenues. The slideshow began with background on the project, including development decisions and environmental cleanup. Next, the project team shared an overview of community design events, the emerging vision and priorities, and the initial feedback on two alternative designs that were shared with the community in August and September. Several citizens voiced questions related to soil remediation and traffic, while others voiced supportive comments and excitement about the coming park. City staff and the design consultants answered Councilmembers' questions, and the Council expressed support to move on to the next phase of the project--moving towards a final, preferred concept to implement.

Watch the Council Meeting Project Update Video

Instructions to turn on captions on YouTube:

  1. Tap the cog icon (the settings menu)
  2. Tap Subtitles/CC (1)
  3. Tap English (auto-generated)
  4. Tap Subtitles/CC (1) again
  5. Tap Auto-translate
  6. Scroll down to your preferred language

Morelos Hall - 9/29/24

On Sunday, September 29th, a representative from the design team presented the park concepts of the Sociedad Mutualista Mexicana de Morelos, also known as Morelos Hall. The meeting was a regular monthly meeting and approximately 25 people attended. The presenter informed visitors in Spanish about the two alternative park concepts and described the differences between each design. Participants asked questions about each concept and offered suggestions on how to adjust the designs. Participants were also encouraged to fill out a survey after the event.

Centennial Way Park South Grand Opening - 9/29/24

On Sunday, September 29th, South San Francisco staff and the design team attended the Centennial Way Park South Grand Opening from 10 am-12 pm. Approximately 20 people visited the tent. The design team informed participants about the two alternative park concepts, answered questions, recorded comments, and shared the online survey with passersby. Several informed participants took the survey on their mobile devices and the provided iPads.

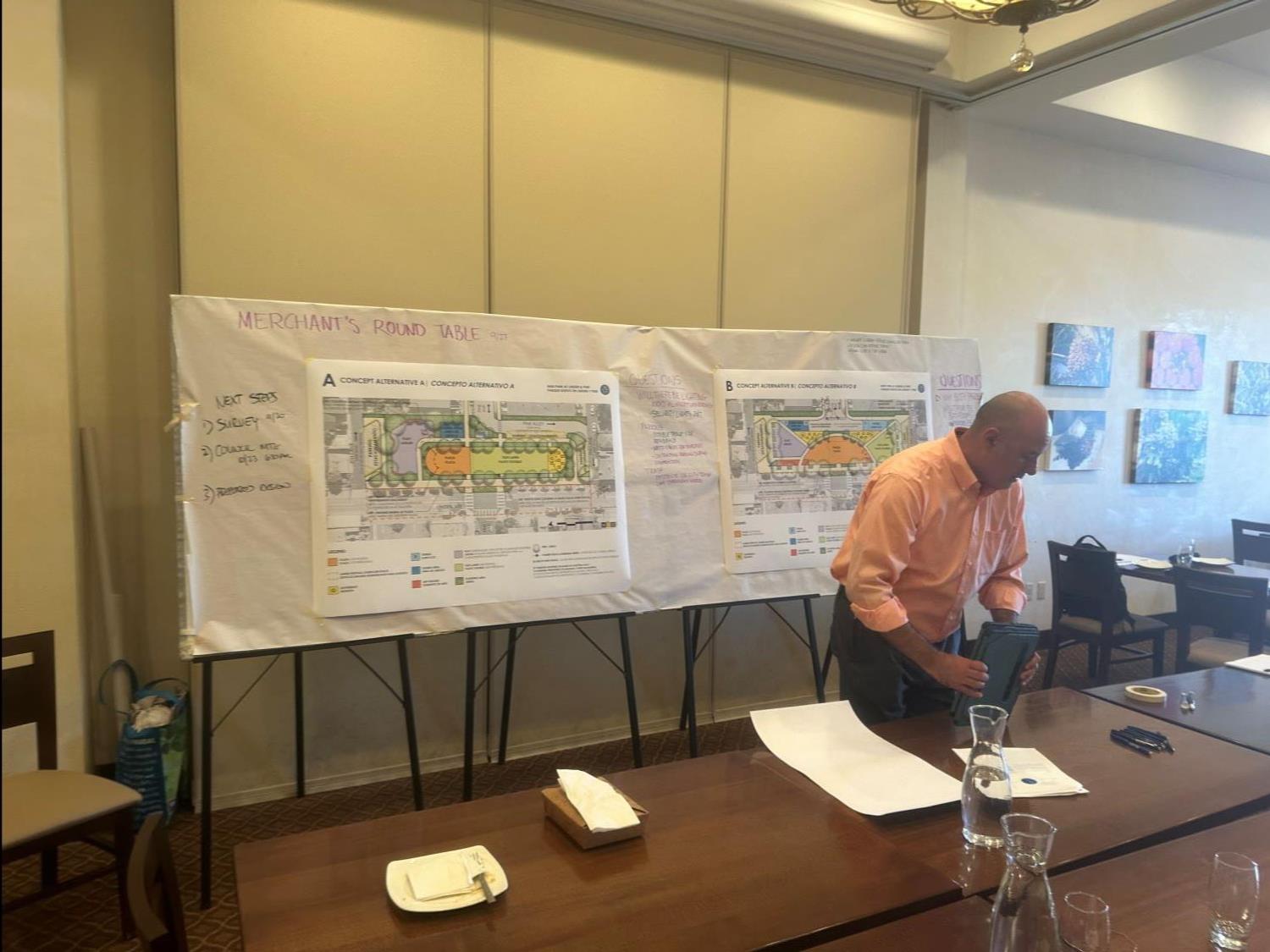

Merchants' Round Table - 9/27/24

On Friday, September 27th, South San Francisco staff, including the Fire Marshal, and the design team hosted a second Merchants’ Round Table event. Five local business owners attended the event held in Amoura’s restaurant across the street from the park area. The participating business owners sat down with City Staff and the design team to discuss concerns, including traffic circulation, emergency access, and parking strategies.

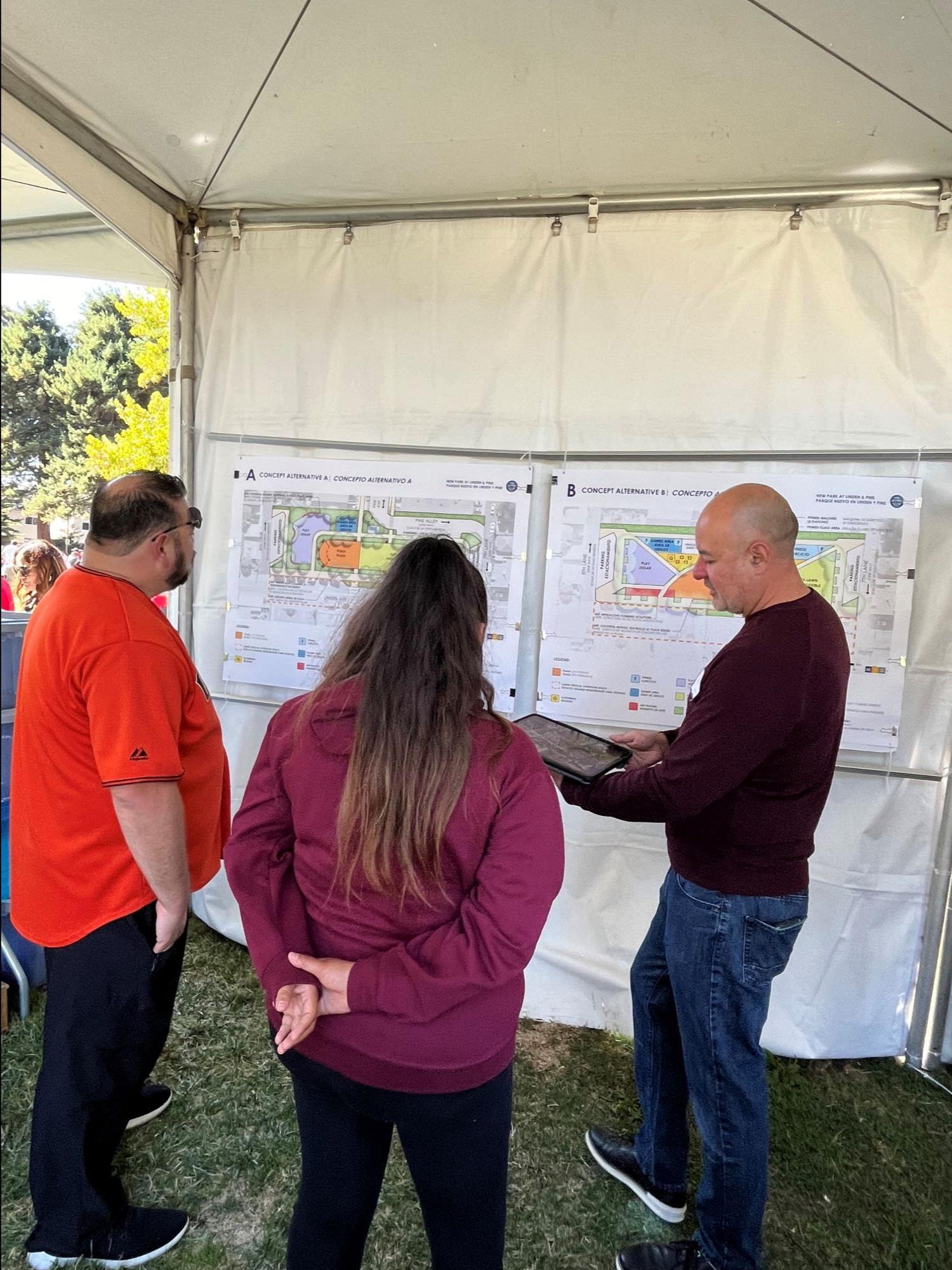

Concert in the Park - 9/21/24

On Saturday, September 21, South San Francisco staff and the design team attended the Concert at the Park at Orange Memorial Park from 11 am-3 pm. Approximately 40 people visited the tent. The design team provided an overview of the two alternative park concepts, answered questions, recorded comments, and provided the online survey to interested participants. The bilingual survey was provided to participants on iPads or paper. Staff also handed out South San Francisco Parks and Recreation refrigerator magnets to attendees.

South San Francisco Youth Commission - 9/9/24

On Monday, September 9, South San Francisco staff presented an update of the park project to the Youth Commission. Printed copies of the survey and links to the online survey were provided to the Commission.

Open House Event 2 - 8/24/24

On Saturday, August 24th, South San Francisco staff and the design team hosted an Open House from 9:00 am - 1:00 pm at the future park site (700 Linden Ave). Approximately 60 people visited the event tents, where staff gave an overview of the concepts, answered questions, and recorded comments. Participants were also encouraged to take a bilingual online survey either on their own phones or on the ipads provided with staff assistance.

Movie in the Park - Pop-Up Event - 8/16/24

On Friday, August 16th, City staff and the design team hosted a Pop-Up station at South San Francisco's Movie Night in the Park, held at Martin Elementary School from 6:00 p.m. – 8:00 p.m. About 25 people evaluated the two design concepts, providing valuable feedback to help guide the final design.

National Night Out Tabling Event - 8/6/24

On Tuesday, August 6th, South San Francisco staff and the design team hosted a table at National Night Out at the Paradise Valley Recreation Center. About 20 participants stopped by to review community input from the project's Visioning Phase and learn about upcoming public events to weigh in on two design alternatives. Firefighters, police officers, and waste management staff were among the attendees, and shared their ideas on several possible street configurations.

Visioning Phase Summary - 7/24/24

Thank you to all who participated in the Open House + Listening Session, Pop-Up Event, Merchants' Round Table and provided feedback during the Visioning Phase for the new park at Linden and Pine.  A summary of these engagement activities and feedback gathered is available below.  The next phase of engagement and design will kick off in early August and run through September.

Visioning Phase Summary(PDF, 6MB)

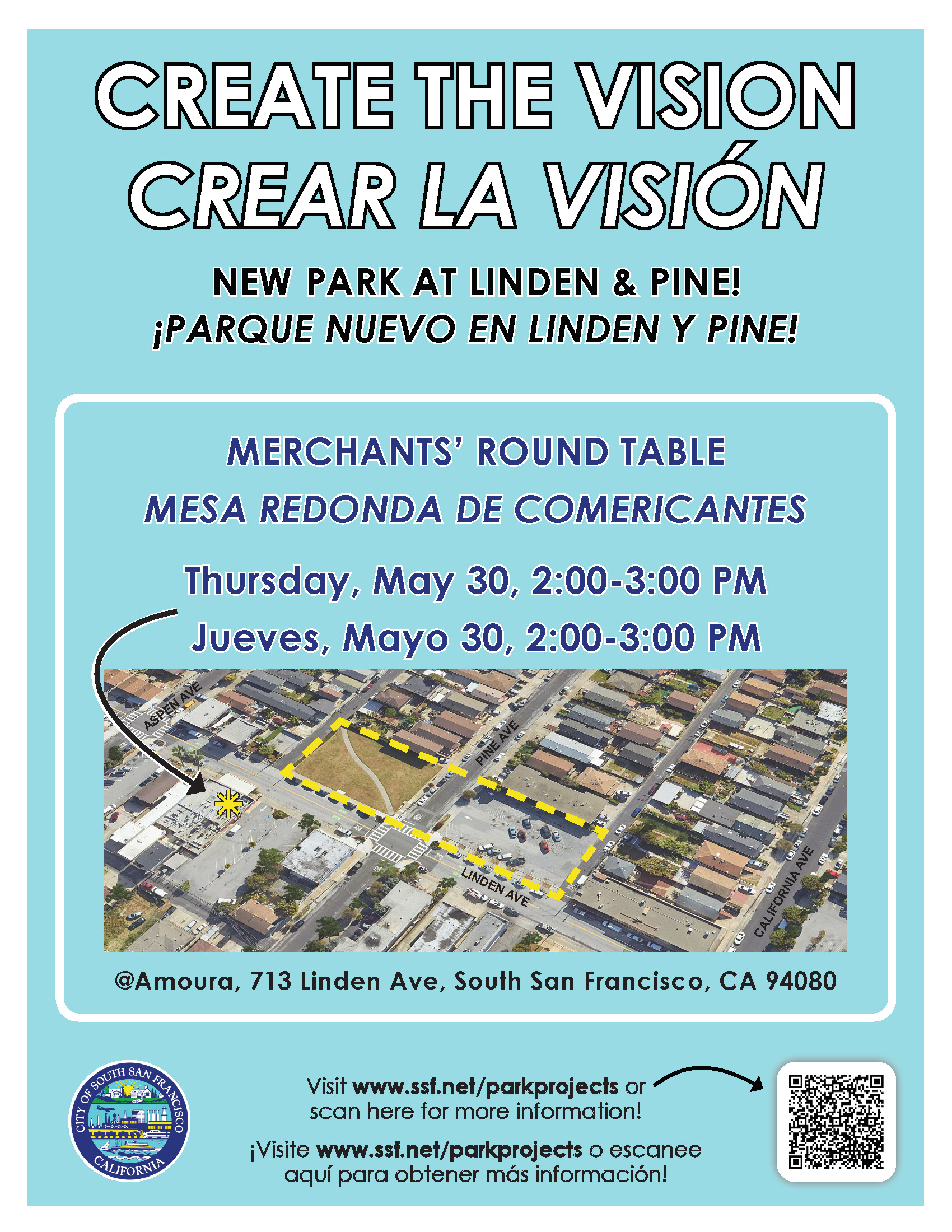

Merchants' Round Table - 5/30/24

May 30th, 2024, Thursday  |  2:00 – 3:00pm  |  Amoura Restaurant, 713 Linden Ave., SSF

City staff and the design team held a focus group session with the neighboring business owners at Amoura’s restaurant, across the street from the new park. The discussion centered on business-specific topics such as parking, loading, safety, activation and customer experience. The group also looked at examples showing how other parks have supported surrounding businesses, including drawing in more daily customers and providing outdoor seating options. The design team will integrate what was learned into the upcoming park concepts to create a win-win for both neighbors and businesses.

Linden Park Merchants' Roundtable flyer

Visioning Pop-Up - 5/1/24

Visioning Pop-Up | 700 Linden Ave | Wednesday, May 1, 2024

On Saturday, April 13, 2024, the City of South San Francisco sponsored an Open House & Listening Session to create the vision for a new park at the intersection of Linden Ave. and Pine Ave. The event was held in the parking lot at 616 Linden Ave., from 10 a.m. to 1 p.m. Participants had the opportunity to describe their current and past activities at the site and comment on potential preferences for the new park. Along with speaking directly with City and design representatives, participants used various methods to share their ideas and priorities. Preliminary results show a preference for community gathering and play spaces.

Missed it? Join us at the next public Visioning Event - Wednesday, May 1st from 4 p.m. to 7 p.m. - at the new park location, 700 Linden Ave.

Next Steps:  After the public Visioning events, several design alternatives will be developed and shared with the public for additional input in June and July. Your feedback will help guide the final concept plan for the new park. Sign up to receive project updates to be notified of the next events for input.

Open House - 4/13/24

Linden Park Open House flyer English Linden Park Open House flyer Spanish

Additional Information

Get Updates

Sign up to receive updates about this specific project at our newsletter subscribe page.

FAQs

What is the design process?

The three key phases to community engagement during the design phase are:

Phase 1: Visioning: April - May 2024
Phase 2: Alternatives: August - October 2024
Phase 3: Final Concept: February - March 2025

How can people share ideas and inform the design?

Engagement activities will include Open Houses, Pop-Up Events, Stakeholder Interviews, Focus Group Meetings, and Surveys. Be sure to sign up for the mailing list to receive notices about future outreach opportunities.

How can I stay informed about the design?

The project webpage will include latest designs, upcoming engagement opportunities, and past meeting materials. Be sure to sign up for the mailing list to receive notices about future outreach opportunities.

How can I learn about engagement opportunities?

Sign up to receive updates about the project at our newsletter subscribe page.

How are you reaching out to the community?

Regular email newsletters, direct mailers, hand delivered flyers, social media, park kiosk posters, word of mouth with community members.

Is the site contaminated?

Gasoline and waste oil underground storage tanks were removed in 1993, and an environmental case was opened and overseen by San Mateo County Groundwater Protection Program.  Between 1993 and 2001, 440 cubic yards of contaminated soil were removed from the property and groundwater samples were collected routinely. Extensive soil testing was completed in June 2023 and again in February 2024. In accordance with state and county health department policy for former gasoline station sites, testing confirmed the site is safe for use as a park.

Lead soil was identified in a small portion of the 616 Linden Ave parcel.  While deemed safe for use as a park with the soil capped on-site, the project will voluntarily remove the soil as part of the park construction project.

Prior to park construction, a Site Management Plan (SMP) will be prepared and submitted to San Mateo County Groundwater Protection Program (GPP) for review. This Plan will describe recommended steps necessary to ensure safety of workers, residents, and park users during construction. It will also describe procedures that will be followed if petroleum hydrocarbon impacted soils are encountered during construction, although this is not expected. Further, any soils planned for off-haul to a landfill will be tested and disposed of accordingly.

The City plans to voluntarily remove the lead-impacted soil located within the buried concrete structure at 616 Linden Avenue that was identified during the Phase II Environmental Site Assessment. This work will be proposed in the SMP described above and submitted to the San Mateo County Groundwater Protection Program for review.

Environmental Summary Report 616 and 700 Linden Avenue - 2024(PDF, 3MB)
Reporte Ambiental Resumido 616 y 700 Linden Avenue - 2024(PDF, 3MB)

When was information about soil conditions shared publicly?

Stakeholder interviews were conducted in January and February 2024 as part of Phase 0 outreach. During these stakeholder interviews the project team presented overall site conditions, which included history of the 616 Linden as an automotive shop and identified key issues as soil remediation and utilities relocation.

Phase 0 Presentation(PDF, 5MB)

Additional information related to soil conditions were posted on the City’s website in April 2024. At the October 23, 2024 City Council meeting, City staff and the design team presented information on the site history and environmental cleanup. A recording of this council meeting is available here.

Where can I access information about the 616 Linden / Volante Automotive Clean-Up Case?

Information about the Volonte Automotive underground storage tank removal case (T0608100720) is available on GeoTracker operated by the State Water Resources Control Board.

https://geotracker.waterboards.ca.gov/profile_report?global_id=T0608100720

Public inquiries and responses from the State Water Resources Control Board and San Mateo County Environmental Health are available on GeoTracker as well and includes, but not limited to the following:

Will there be on-site parking?

With the understanding that the available land area of the two lots is very limited, the project team responded to the community concerns about the loss of parking at 616 Linden by incorporating 17 spaces into the park concept design.

Will Pine Ave. be closed as part of this project?

Circulation options were explored, some of which include closing Pine Ave to through traffic. All options took into consideration circulation for emergency vehicles, trash pick up, and neighborhood egress.

Traffic analysis of the proposed Linden Park circulation alternatives showed that all alternatives would be feasible to implement. Analysis of the existing roadway volumes and intersection operations during weekday peak hours showed that the roadways and intersections surrounding the park are operating well below capacity and therefore could accommodate additional traffic that would be diverted from Pine Avenue and no significant operational issues are anticipated for the Pine Avenue closure alternatives.

Staff engaged South San Francisco Fire and Public Works/Engineering Departments to review the Pine Avenue alternatives. Fire noted emergency response times would not be impacted by any of the alternatives. Fire also noted both Aspen Avenue and California Avenue provide adequate response routes in the alternatives where Pine Avenue is either partially or entirely closed.  Additionally, both Cypress Avenue and Airport Boulevards support access and are preferable when evaluated as evacuation routes based on their network capacity when compared with Linden Avenue. Engineering noted no anticipated impacts to operation and services. Staff also engaged South San Francisco Scavengers who reviewed the alternatives and found that with either full closure or the alley bypass they would be able to adequately maintain service to residents along Pine Avenue.

Has the park design project been reviewed per the California Environmental Quality Act (CEQA)?

Once a concept design for the park is approved by City Council, the City will determine and conduct the appropriate level of CEQA analysis, which will disclose any potential environmental impacts and mitigation measures. The CEQA review will likely take place in the early part of 2025.

Will there be a restroom facility at the park?

This park is classified as a "neighborhood park," which typically does not include a restroom. However, we recognize the community’s strong interest in having one. While the current budget does not include the cost of a restroom, the concept design includes space for a future facility. The project team is actively exploring additional funding options to incorporate a restroom into the initial construction. Discussions on this topic will continue, as well as discussions with City Council at future Council Meetings on funding strategies.

Will there be space for food trucks?

The concept design includes space within the park for pop-up vendors during events. Food truck could be accommodated near the park, but outside of the park footprint.

How will the park be maintained?

The City is committed to providing regular maintenance of the park space, including plantings, irrigation, lighting and general cleaning.

Will the Pine & Cypress Lot be redeveloped as part of this project?

The funding in-hand is dedicated to the new Park at Linden and Pine project. The City is exploring the use of CBDG funding to make ADA accessibility upgrades, which would make the park eligible for more grant funding opportunities. It is important to stress that the City is committed to pursuing park improvements at Cypress and Pine Park.

How is the project funded?

The project is funded through a combination of State Grants, Park Impact Fees and developer contributions.

If not developed as a Park, what other uses are possible for 616 and 700 Linden Avenue?

Both 616 and 700 Linden Avenue were owned by the former South San Francisco Redevelopment Agency (RDA). In 2012, all redevelopment agencies in California were dissolved and the Successor Agency to the RDA prepared a plan for State approval to govern the use and/or disposition of all former RDA properties. This plan, known as a Long-Range Property Management Plan (LRPMP), was approved by the State in 2015. In accordance with the LRPMP, 616 and 700 Linden were conveyed to the City. The LRPMP notes that the highest and best use of these properties is for high density housing; however, the LRPMP does not require the City to sell the properties for housing or any other purpose.

If City Council opted to sell the properties rather than develop them as parks, the City would have to follow the process required by the Surplus Land Act, as amended by the State Legislature in 2019. As part of the process, the City must provide notice to specified entities regarding the availability of the property. If a housing development entity notifies the City of its desire to acquire the property for low and moderate-income housing, the City must engage in good-faith negotiations with the entity to convey the property for that purpose. The developer must make at least 25% of the units available at an affordable cost to lower-income households. If the City and developer are not able to agree on price and terms after good-faith negotiations, the City may sell the property without following the Act. However, if 10 or more residential units are developed on the property, not less than 15% of the total number of residential units must be sold or rented to lower income households. There has been developer interest in constructing housing on the sites, but the City has prioritized using them for a park for the neighborhood.

Has the City issued a permit to close or redirect Pine Avenue?

Once a concept design for the park is approved by City Council and as the project design advances, all required permits will be obtained before construction begins. Additional traffic and circulations studies will be performed as necessary to obtain street closure permits, if applicable.

Contact

For additional questions or information that is not listed here, please email parkprojects@ssfca.gov and a staff member will respond to you.

Location

Linden Ave & Pine Ave,  94080  View Map
